Why Exhibition Stands Always Take Longer To Build Than Clients Expect (And It's Usually Not The Build)
Why Exhibition Stands Always Take Longer To Build Than Clients Expect (And It’s Usually Not The Build)
Almost every exhibition project starts with the same reassuring sentence.
“It’s only a stand.”
A few walls. Some graphics. A reception counter. Perhaps a meeting room and a screen.
On a render, it can look remarkably straightforward. In a fabrication workshop, however, the visible stand is only part of the job.
The surprising part is that the actual cutting, welding, carpentry, CNC machining, painting and finishing is often not what takes the most time. The longer process is usually turning an attractive concept into a temporary environment that can be engineered, manufactured, transported, installed, operated and dismantled without creating problems for everyone involved.
The Render Is Usually the Beginning
One of the biggest misconceptions in exhibition fabrication is that manufacturing starts when the render is approved.
In reality, an approved render often marks the point where the fabrication team can begin asking the questions that the image was never intended to answer.
Concept visuals are excellent at communicating atmosphere, proportions, branding and creative intent. They are not always designed to explain wall build-ups, fixing points, cable routes, access panels, fire-performance requirements, structural connections or how a six-metre feature will physically pass through the loading dock.
That is completely normal.
A concept image has a different job. It sells the idea. Technical development then has to convert that idea into a set of buildable decisions.
This distinction has become even more noticeable with the increasing use of AI-generated imagery. It is now possible to produce extremely convincing exhibition concepts very quickly. They can be imaginative, visually polished and useful during early creative conversations.
What they cannot automatically provide is construction logic.
A wall may apparently float. A screen may be embedded into a surface with no visible structure behind it. A feature may have geometry that would be exceptionally difficult to manufacture.
Storage, power, servicing and access may simply not exist.
That does not make the visual wrong. It simply means the next stage of work has not happened yet.
A Beautiful Image Does Not Need A Store Room
One of the first things technical development tends to reveal is that exhibition stands require considerably more practical space than the render suggests.
A reception area may contain brochures, merchandise, catering equipment, spare stationery, staff belongings, bottled water and cleaning materials.
In the concept, these things apparently disappear when they are not being used.
Real exhibition teams are less magical.
Back-of-house space has to come from somewhere. Storage cupboards need usable door swings. Shelving needs sufficient depth. Refrigeration may require ventilation. Staff need somewhere to put supplies. Equipment needs to remain accessible throughout the show.
Introducing these functions can change wall thicknesses, room sizes and circulation.
The challenge is to integrate them without making the stand feel compromised. Good technical development hides operational requirements inside the architecture rather than allowing them to look like additions made after everything else was finished.
Sometimes a wall that appears 150mm deep in a render becomes 400mm deep because it contains storage, steelwork, cables and equipment.
Visually, very little may change.
Operationally, almost everything has improved.
Meeting Rooms Have To Work As Rooms
Meeting rooms create a similar problem.
On a plan, a table and six chairs may technically fit within a room.
That does not necessarily mean six people can comfortably use it.
People need enough clearance to pull chairs backwards, walk around the table, enter through the door and move through the space without asking everyone else to stand up.
Doors also need somewhere to swing. Screens need appropriate viewing distances. Power and data may be required around the table. Air movement needs to be considered, particularly in enclosed meeting spaces positioned inside a busy exhibition hall.
Acoustic expectations matter as well.
A lightweight scenic partition beside a crowded aisle behaves very differently from a conventional office wall. Where privacy is important, the wall build-up, door detailing, ceiling treatment and service penetrations all need to be considered.
Again, the objective is not to redesign the creative concept unnecessarily.
It is to make the room function like a room.
Technology Takes Up More Space Than The Screen
Technology integration creates another layer of hidden development.
A display screen is not simply a rectangle on a wall.
It has weight. It needs brackets. It needs power and signal infrastructure. Cables require routes and sensible bend radii. Equipment may generate heat. Screens, processors and power supplies eventually require maintenance.
LED installations may require front or rear servicing, and that decision can completely change the construction behind the display.
Interactive screens introduce further considerations. Sensors, media players, speakers, networking equipment and control systems may all need to be concealed somewhere within the scenic construction.
The cleaner the finished stand looks, the more coordination may be happening behind the surfaces.
A perfectly flush screen installation can therefore require considerably more technical development than simply mounting a display to a wall.
Structural Requirements Are Rarely Visible In The Concept

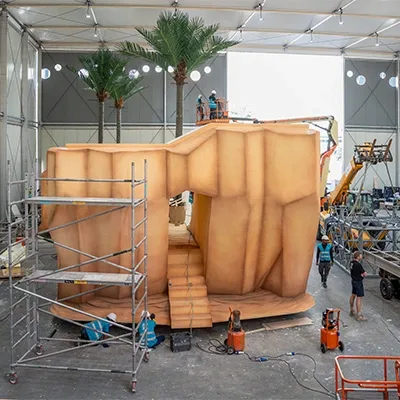

Large exhibition features often appear deliberately lightweight.
Tall portals, suspended structures, projecting canopies and oversized branded walls may have very little visible structure.
Physics remains less interested in the visual intention.
Loads still need to travel safely through the structure and into suitable bases, floor systems, overhead rigging or approved structural connections.

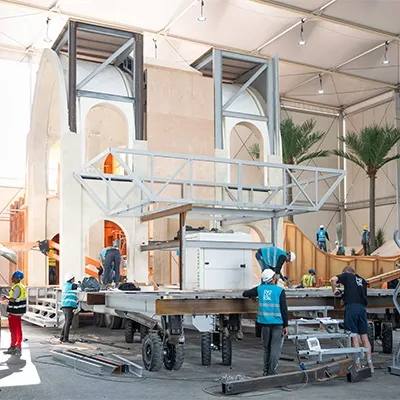

This is where scenic engineering and metal fabrication frequently become part of what initially appeared to be a straightforward carpentry package.
Steel frames may need to be introduced inside timber-clad walls. Connection plates may be developed. Bases may become larger. Bracing may be concealed inside cavities. Ballast requirements may influence the lower sections of the structure.
The method also has to account for assembly.
A structure that is perfectly stable once complete may still need temporary support while individual modules are being connected during installation.
None of this engineering should alter the creative intention unnecessarily.
The aim is for the structure to behave properly while keeping the engineering visually quiet.
Value Engineering Is More Than Making Something Cheaper
Value engineering also tends to happen during this period, and the term is frequently misunderstood.
Good value engineering is not simply an exercise in removing cost.
It is a review of how to achieve the required appearance, durability and performance through a more efficient construction method.
A complicated curved wall might be rationalised into repeatable CNC-cut ribs. A solid-looking architectural feature may become a lightweight framed assembly. An expensive surface material might be recreated through laminates, scenic painting, printed finishes or another manufactured system better suited to temporary use.
A seemingly minor change in construction can dramatically reduce workshop hours, weight, transport volume or installation time while producing almost no visible difference in the finished environment.
Transport itself can influence these decisions.
A scenic element that can theoretically be fabricated as one enormous piece may be significantly more practical as three accurately indexed modules that fit onto standard vehicles and reconnect cleanly on site.
That is value engineering through buildability rather than simple cost cutting.
The Exhibition Hall Has Its Own Opinion

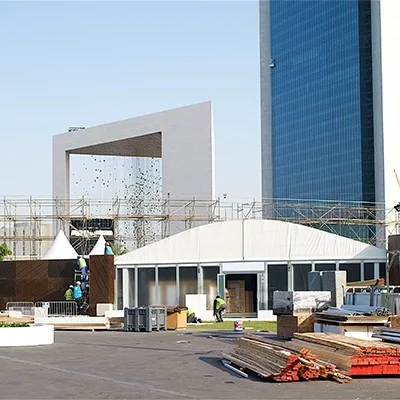

Then there is the exhibition hall itself.
Every venue introduces rules that have absolutely nothing to do with how attractive the render looks.
There may be maximum construction heights, floor-loading limits, approved fixing methods, fire-certification requirements, rigging restrictions, hot-work controls and limitations on when specific installation activities can take place.
Loading docks have dimensions.
Service lifts have dimensions.
Doors have dimensions.
Vehicle movements may require booked delivery slots. Forklifts and access equipment may only operate in particular areas. Packaging and empty transport cases need somewhere to go once the stand is inside.
In some venues, the largest scenic component that can be comfortably manufactured in the workshop simply cannot physically reach the stand location at its finished size.
That discovery is considerably more useful during technical drawing than at two o’clock in the morning on installation day.
Venue restrictions therefore become fabrication inputs.
They determine module sizes, connection systems, packing methods and sometimes the entire installation sequence.
Buildability Reviews Prevent Expensive Surprises
A buildability review brings all of these considerations together.
The concept, engineering, fabrication method, transport strategy and venue conditions are considered as one system.
Experienced fabrication teams tend to look closely at interfaces because interfaces are where apparently simple projects become complicated.
Can the wall be assembled in the available sequence?
Can the ceiling feature be lifted safely?
Can the graphics be applied in the workshop, or will modular joints become visible?
Can the screen be removed if it fails?
Can someone physically reach the bolts required to connect the steel frame?
Will the finished counter fit through the service lift?
Can the structure be dismantled without destroying it?
These questions can seem excessively detailed while the project still exists on screen.
On site, they become extremely practical.
A few hours spent resolving a connection detail in technical development can prevent a much longer discussion involving a drill, a grinder and several people standing around a half-finished wall at midnight.
Installation Planning Starts Before The Truck Leaves
Installation methodology should therefore develop alongside fabrication.
Components need to arrive on site in a useful order, not simply in the order they happened to be completed in the workshop.

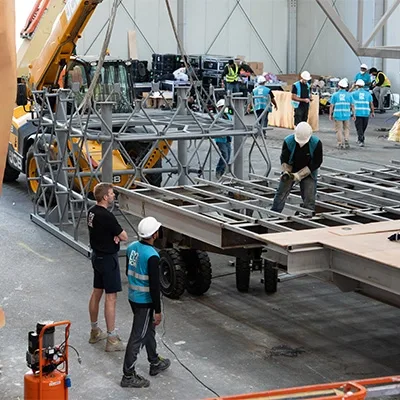

Primary steelwork may need to arrive before wall panels.
Services may need to be installed before cladding closes access.
AV equipment might need to enter a structure before decorative panels make the opening smaller.
Graphics and delicate scenic finishes may need to remain protected until heavy installation work is complete.

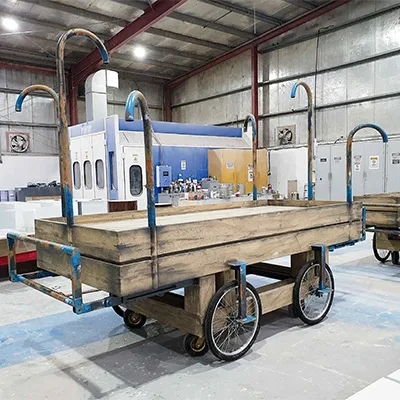

A stand containing twenty obvious visual elements can easily contain many more concealed components, brackets, fixings, access pieces and numbered modules.
Packing and labelling therefore become part of the build methodology.
A beautifully fabricated component is not particularly helpful if it is buried underneath six tonnes of other scenery at the back of the wrong truck.
Good logistics should make the installation sequence feel almost obvious.
The right item arrives when it is needed, in a condition that allows it to be installed immediately.
Sometimes The Concept Has To Evolve
There are projects where technical development results in very little visible change.
There are others where the original concept evolves substantially before fabrication begins.
A feature wall may become deeper to accommodate structure and technology.
A store room may appear behind what was originally a decorative surface.
A meeting room may grow slightly so the furniture actually works.
A suspended element may be divided into lighter modules.
A sculptural feature may be rebuilt around a concealed steel skeleton so it can be transported and installed safely.
From the outside, these can look like design changes.
From a fabrication perspective, they are often the decisions that protect the design by making it possible.
The best development process keeps the important visual characteristics while changing whatever is necessary behind them.
Visitors should still recognise the original concept.
They simply receive a version that also works.
Why The Workshop Is Waiting
This explains the period that can sometimes feel frustrating between visual approval and full production.
The workshop is not necessarily waiting for someone to press the start button.
Technical drawings are being coordinated. Structural systems are being reviewed. Material availability is being checked. Samples may be produced. Technology is being coordinated. Connections are being developed. Venue requirements are being incorporated. Installation sequences are being discussed.
In some cases, prototypes or partial workshop assemblies are created to check particularly difficult details before committing to the final build.
Starting fabrication before this information is stable can feel faster for a few days.
It normally stops feeling fast when panels need to be remade, steelwork needs modifying, integrated technology no longer fits or site conditions force changes that could have been resolved beforehand.
Technical development is therefore not time lost before fabrication.
It is part of fabrication.
The Finished Stand Should Hide The Effort
At Evolution Scenic, the task is not simply to reproduce what appears in a render.
The real work is resolving the practical, structural, operational and logistical requirements that allow the environment to function in the real world while preserving the original creative intent.
That can involve scenic carpentry, steel fabrication, CNC machining, graphics, integrated technology, specialist finishes, structural support, transport engineering and detailed installation planning.
When that process is done properly, visitors see none of it.
They see clean finishes, precise graphics, integrated screens, comfortable meeting spaces and architectural features that appear effortless.
They do not see the revised wall build-up.
They do not see the concealed steel frame.
They do not see the removable service panel.
They do not see the numbered transport modules.
They do not see the cable route behind the display or the discussion about whether a scenic feature can physically make the turn between the loading dock and the exhibition hall.
Which is probably how it should be.
The best exhibition fabrication quietly solves hundreds of practical problems.
By opening day, all that complexity has disappeared into something that looks, once again, like “only a stand.”
