• Why CNC Production Matters In Scenic Fabrication

    Image description

    Why CNC Production Matters In Scenic Fabrication

    Modern scenic fabrication increasingly relies on digital manufacturing to achieve levels of accuracy, consistency and production efficiency that would be difficult to maintain through traditional methods alone.


    Whether the project involves an exhibition environment, a large branded installation, a retail pop-up or a highly detailed cultural structure, CNC production gives fabrication teams a controlled way to translate complex design information into physical components.


    What makes CNC particularly valuable is the connection it creates between design development and manufacturing. Geometry produced during the CAD and technical drawing stages can be prepared directly for production, allowing components to be cut, shaped and repeated with a high degree of accuracy. This reduces unnecessary interpretation on the workshop floor and helps ensure that what has been technically developed is reflected in the parts being manufactured.


    Image description

    From CAD to machine-ready production


    The CNC process begins long before a cutting tool touches material. Reliable production depends on clean CAD geometry, clearly defined dimensions and an understanding of how each component will eventually be assembled.


    Fabricators need to consider material thicknesses, joint locations, edge conditions, fixing methods and realistic machining tolerances while preparing the digital files. A visually correct model is not automatically a production-ready model.


    Once the geometry is resolved, components can be nested onto sheets and translated into machine toolpaths. Nesting becomes particularly important when significant quantities of plywood, MDF, acrylic or composite sheet material are involved, because efficient layouts can reduce material waste considerably.


    Tool diameter, cutting direction, hold-down strategy and the sequence in which parts are machined all influence the quality of the finished components.


    CNC production is therefore not simply a matter of sending a drawing to a machine; the manufacturing logic has to be considered throughout the file preparation process.

    Nested CNC toolpaths arranged efficiently across plywood for scenic component production

    Nesting, toolpaths and tolerances are resolved before material reaches the CNC bed.

    CNC routing for complex scenic construction


    CNC routing is one of the most useful digital manufacturing processes within scenic carpentry.


    Sheet materials can be cut into structural ribs, wall profiles, templates, decorative panels, flooring components, signage elements and intricate joinery with consistent results. For scenic structures that rely on layered construction or complex profiles, routing allows shapes to be reproduced accurately without requiring every component to be manually marked and cut.


    Curved structures are a good example. A flowing scenic wall may require dozens of ribs, formers or profiles, each slightly different from the next. Producing those pieces manually would introduce considerable setting-out time and increase the possibility of cumulative dimensional errors.


    CNC-machined components allow the geometry to be controlled digitally before the structure reaches the assembly stage, giving scenic carpenters a much more reliable starting point for the build.

    Evolution Scenic CNC router cutting plywood components for a scenic wall assembly

    CNC routing produces accurate plywood parts for complex scenic structures and feature walls.

    Beyond sheet materials: foam and sculptural production


    Digital manufacturing also extends into sculptural scenic work.


    CNC foam cutting, hot-wire cutting and more advanced machining processes can generate large three-dimensional forms that would otherwise require extensive manual carving. These processes are particularly useful for oversized props, architectural features, mould-making forms and complex decorative elements.


    The digitally produced shape may only be the beginning of the fabrication process; scenic artists can then carve, texture, hard-coat, paint and finish the surface to achieve the required appearance.

    Image description

    Accuracy and repeatability


    One of CNC production’s greatest advantages is repeatability. Producing one component accurately is useful, but producing fifty components that match one another closely can transform the efficiency of a scenic build.


    Repeated display units, decorative details, structural ribs, plinth components or branded elements can be manufactured from the same controlled digital information rather than being individually set out by hand.


    Accuracy also improves the way separate workshop disciplines interact. Correctly machined joints help timber assemblies fit together more predictably.


    Locating holes can control alignment between components. Templates can position metal brackets consistently, while accurately produced formers can guide cladding and finishing work. The objective is not to chase unrealistic machining tolerances for their own sake, but to use appropriate precision to make the wider fabrication process more controlled.

    Identical CNC-machined scenic components stacked ready for repeatable workshop assembly

    Repeatability keeps matching components consistent across one-off builds and large production runs.

    Scaling scenic manufacturing


    These advantages become increasingly important as projects increase in size. A scenic installation containing hundreds of individual components can quickly become difficult to manage if every piece depends on manual measurement. Digital manufacturing allows components to be organised, labelled and reproduced systematically.


    Part identification can be incorporated into production files, allowing workshop teams to understand where individual pieces belong during dry fitting and final assembly.


    Scalability also matters when a scenic environment needs to be reproduced across multiple locations. Retail installations, pop-ups and branded environments often require similar structures to be manufactured more than once, sometimes with minor adaptations for different sites.


    Once the manufacturing information has been properly developed, CNC-ready components can be reproduced or adjusted without rebuilding the fabrication process from the beginning. The digital production file effectively becomes part of the project’s manufacturing knowledge.

    Evolution Scenic labelled CNC components organised for a large-scale scenic fabrication build

    Digital production helps large scenic projects remain organised as component quantities increase.

    Heritage-inspired fabrication


    CNC production is particularly useful for cultural and heritage-inspired work where repeated geometric details can become extremely complex. Decorative screens, layered patterns, relief panels and architectural motifs may involve hundreds of carefully controlled curves or intersections. Digital drawing allows these elements to be developed accurately, while CNC machining makes it practical to reproduce the geometry at scenic scale.


    The machine itself does not create authenticity, however. Heritage-inspired scenic fabrication still requires careful interpretation of proportion, material, depth and finish. A precisely cut pattern can feel completely wrong if its scale or surface treatment has been poorly considered.


    The value of CNC lies in giving the fabrication team control over the geometry, leaving experienced craftspeople and scenic artists to determine how that geometry should ultimately look and feel.

    CNC-carved heritage-inspired pattern within a decorative scenic panel for cultural fabrication

    CNC machining can reproduce intricate heritage geometry while retaining controlled scale and proportion.

    Digital production meets traditional workshop skills


    CNC production does not replace scenic carpentry, metal fabrication or skilled workshop labour. A router cannot decide whether a timber edge requires reinforcement, whether an assembly can realistically be lifted into position or whether a connection will remain accessible during installation. Those decisions still depend on experienced fabricators understanding how the components will behave once they leave the machine bed.


    In practice, digital manufacturing works best when it supports traditional workshop disciplines. CNC-cut parts may be assembled by carpenters, reinforced by fabricated steelwork, clad with sheet materials and passed to scenic artists for finishing.


    The machine can also manufacture jigs, setting-out templates and drilling guides that make manual processes more consistent. This relationship between digital accuracy and practical fabrication judgement is where much of CNC’s real value sits.

    Evolution Scenic carpenters assembling CNC-machined components into a practical scenic structure

    Machine accuracy becomes useful only when experienced fabricators turn components into buildable scenery.

    Installation efficiencies start in the workshop


    Accurate components can also reduce installation time. Scenic structures are frequently assembled under tight site programmes, with limited opportunities for significant adjustment once materials arrive. Components that have been dry-fitted and manufactured within a controlled digital workflow are more likely to align correctly when reassembled.


    Predetermined fixing points, repeatable interfaces and accurate panel dimensions can remove a considerable amount of measuring and modification from the site team.


    The same approach supports transportation and modular construction. Large structures can be divided digitally into sections that suit vehicle capacities, access routes and installation sequencing.


    Modules can be numbered before leaving the workshop and their connection points coordinated during manufacture.


    CNC accuracy therefore contributes not only to the appearance of a finished scenic structure, but also to how efficiently it can be packed, transported and reconstructed.

    Pre-machined scenic panels aligning accurately during efficient on-site installation

    Accurate machining reduces adjustment on site and helps installation teams assemble structures efficiently.

    Precision is only useful when it builds well


    The most successful use of CNC in scenic fabrication is not about replacing traditional manufacturing with machines.


    It is about using digital production where it genuinely improves the build. CNC routing, foam cutting and other manufacturing processes allow complex information to move efficiently from technical design into the workshop, improving repeatability, scalability and control.


    But scenic projects still depend on skilled people making practical decisions. Materials move, tolerances accumulate and installation conditions rarely behave exactly as they do inside a CAD model. By combining CNC precision with experienced carpentry, metal fabrication, scenic finishing, logistics and installation knowledge, fabrication teams can produce complex environments that are both digitally accurate and genuinely buildable

    Finished scenic structure combining CNC precision with traditional hand fabrication and finishing

    The strongest results combine digital manufacturing accuracy with experienced scenic fabrication judgement.

  • Installing Large Scenic Structures

    Image description

    Installing Large Scenic Structures


    Fabrication is only one part of delivering a large scenic structure. The process of transporting, lifting, assembling and commissioning it on site can introduce constraints that influence almost every decision made during design and production.


    Large structures rarely arrive fully assembled. Vehicle dimensions, road restrictions, venue access, lifting capacity and available installation space usually require the build to be divided into transportable modules. Those modules must then reconnect accurately, safely and efficiently within a limited installation window.


    This creates a direct relationship between fabrication methodology and installation strategy. Connection details, module sizes, lifting points, transport frames, temporary supports and assembly sequences must be developed before production begins. When installation is treated as a separate final stage, even a well-fabricated structure can become difficult, slow or unsafe to deploy.


    The most successful installations are therefore planned from the site backwards. The final position, access route, lifting method and sequence of work are understood first, allowing the structure to be engineered and fabricated around real site conditions.


    Image description

    Designing and Fabricating for Installation


    Installation planning should begin during the earliest design and engineering stages. Before materials are ordered or fabrication drawings are released, the project team must understand how the completed structure will be divided, transported, handled and assembled.


    A buildability review is one of the most valuable steps in this process. Designers, engineers, workshop supervisors, logistics teams and installation managers review the proposed structure together, identifying anything that may create difficulty during production or deployment.


    This review may examine:

    • The dimensions and weight of each module
    • Vehicle and trailer limitations
    • Loading dock and site access dimensions
    • Available lifting equipment
    • Connection locations and assembly tolerances
    • Temporary stability during installation
    • The order in which components must be installed
    • Access for final fixing, inspection and maintenance


    These considerations often lead to a modular construction strategy.


    A large scenic façade, entrance portal, stage environment or exhibition pavilion may be divided into primary structural modules, secondary framing, cladding panels and decorative elements. Each section can then be fabricated and finished under controlled workshop conditions before being transported to site.


    Effective modularisation is not simply about making components smaller. Modules must be sized around transport, handling and installation requirements while maintaining structural integrity and visual continuity.


    Connection details are particularly important. Bolted plates, splice connections, alignment pins and concealed mechanical fixings must be positioned where installation teams can reach them. Connections should be repeatable and robust enough to accommodate normal fabrication and site tolerances without creating visible misalignment.


    A connection that appears straightforward on a drawing may be difficult to complete when it is positioned several metres above ground, behind cladding or within a restricted access zone.


    Installation managers therefore assess not only whether a connection works structurally, but whether it can be installed safely with the available tools and working space.


    Trial assembly can further reduce site risk. Large or geometrically complex structures may be partially or fully assembled in the workshop before dispatch. This confirms that modules align correctly, connection points are accessible and decorative finishes continue accurately across joints.


    Trial builds also allow installation teams to establish the correct assembly sequence before arriving on site. Components can be labelled, photographed and documented, creating a clear reference for final deployment.


    Lifting points should also be integrated during fabrication. Certified lifting eyes, engineered pick points or temporary lifting attachments allow modules to be handled without damaging the structure or its finished surfaces. Their position must account for the centre of gravity, lifting angle and structural behaviour of the module while suspended.


    Temporary works are equally important. A structure may be stable when complete but unstable during intermediate stages of assembly. Temporary braces, support frames, kentledge, propping systems or restraint cables may therefore be required until all permanent connections are secured.


    Designing these measures in advance prevents site teams from having to develop improvised solutions during installation.

    Image description

    Planning Transport, Access and Lifting Operations


    The route from the workshop to the final installation position must be understood in detail. This includes more than the road journey. It also covers unloading areas, loading docks, service corridors, lifts, doorways, ramps, temporary roads and the final movement of each component across the site.


    Access constraints frequently determine the maximum size of each fabricated module.


    An exhibition pavilion may need to pass through a loading dock with fixed height restrictions. A cultural installation may need to move through an operational building without affecting existing finishes. An urban structure may require delivery through narrow streets during a limited road closure. A waterfront installation may involve soft ground, restricted crane positioning or access from a barge.


    These conditions must be verified rather than assumed.


    Site surveys should record clear dimensions, turning circles, ground levels, overhead restrictions and the load capacity of access routes. Photographs, marked drawings and physical measurements help the production team understand the environment in which the structure will be installed.


    Where possible, installation managers should also review the venue’s logistics regulations.


    Exhibition halls often operate strict delivery booking systems, vehicle time slots, floor-loading limits and working-hour restrictions. Materials may need to arrive in a precise sequence because there is little space available for storage or pre-assembly.


    Public installations introduce different requirements. Road closures, municipal permits, pedestrian controls, security zones and restrictions on noisy or high-risk work can significantly reduce the usable installation period. Delivery and lifting operations may need to take place overnight or within carefully controlled time windows.


    Transport frames help protect large scenic components during these movements. They are designed to support each module, prevent distortion and protect finished surfaces from straps, forks and handling equipment.


    A good transport frame also supports efficient unloading. Components should be packed in the order they will be required, with lifting points and identification labels remaining accessible. If the first item needed on site is positioned behind several later-stage components, valuable installation time may be lost reorganising the load.


    Cranage planning requires similarly detailed preparation.


    Before selecting a crane, the team must understand:

    • The verified weight of each lifted component
    • The required lifting radius
    • The final installation height
    • The crane’s available setup area
    • Ground-bearing capacity
    • Outrigger positions
    • Nearby structures and overhead obstructions
    • Wind limitations
    • Rigging arrangements
    • Exclusion-zone requirements


    The weight of each module should be calculated during engineering and confirmed during fabrication where practical. Decorative cladding, integrated equipment and finishing materials can add considerable weight after the primary frame has been completed.


    The lifting radius is equally significant. Crane capacity reduces as the distance between the crane and the load increases. A module that appears relatively light may require a substantially larger crane if the equipment cannot be positioned close to the installation area.


    Rigging must be coordinated with the module geometry. Spreader beams, lifting slings, shackles and tag lines may be required to control the load and prevent compression or damage. Finished components may also need protective padding where lifting equipment could contact visible surfaces.


    All lifting operations should be supported by an approved lifting plan. This establishes the equipment, personnel, communication procedures, weather limits and sequence required for each lift.

    Image description

    Managing Site Assembly, Temporary Works and Commissioning


    Once components arrive on site, installation must follow a controlled and clearly communicated sequence.


    The first stage is usually site preparation. This may include setting out reference points, confirming floor levels, checking foundations, installing base plates or preparing temporary working areas. Any discrepancy between the surveyed site and the actual conditions should be identified before major structural modules are unloaded.


    Accurate setting out is essential. Small errors at base level can become significant alignment problems higher in the structure. Survey equipment, laser levels and coordinated datum points help ensure that primary frames are positioned correctly before secondary elements are added.

    The sequence of assembly must maintain stability at every stage.


    Primary steel or aluminium frames are generally installed first, followed by secondary supports, scenic cladding, decorative features, graphics and integrated technology. However, the exact sequence depends on access. Some lighting, cabling or internal components may need to be installed before external panels close the structure.


    Temporary works remain in place until the permanent structure is complete and sufficiently stable. Their removal should be treated as a planned activity rather than an informal final step. Engineers may specify that particular connections, ballast systems or structural elements must be inspected before temporary supports are released.


    Exclusion zones are also essential during lifting and overhead work. Only authorised personnel should enter areas beneath or around suspended loads, mobile access equipment and incomplete structures.


    Method statements and risk assessments establish how individual tasks will be carried out. These documents should reflect the actual site conditions, equipment and sequence rather than relying on generic procedures.


    Daily briefings help ensure that workshop crews, riggers, crane operators, access technicians, electricians and scenic installers understand the planned activities and interfaces. Where several teams are working simultaneously, clear coordination prevents one operation from obstructing or destabilising another.


    Exhibition halls present particular coordination challenges because many contractors may be working within the same space. Shared loading routes, limited plant access and strict completion deadlines require careful scheduling. Scenic components should therefore arrive ready for efficient assembly, with unnecessary cutting, painting or modification minimised on site.


    Urban and public environments require additional controls. Work areas may need temporary barriers, traffic management, protected pedestrian routes, noise controls and secured material storage. Structures must remain stable and protected even if installation pauses between permitted working periods.


    Weather can also affect outdoor installations. Wind speed must be monitored during cranage and when handling large scenic panels. Rain, heat and airborne dust may influence adhesives, coatings, electrical connections and working conditions. Contingency measures should be included within the installation methodology rather than developed only when conditions deteriorate.


    After structural assembly, the installation moves into alignment, finishing and commissioning.

    Bolted connections are checked and tightened, structural elements are inspected, and temporary handling marks are repaired. Scenic joints are closed, graphics are aligned and surface finishes are touched up. Integrated lighting, screens, motors or interactive systems are tested in coordination with the relevant specialists.


    A final inspection should confirm that the installed structure matches the approved drawings, remains stable and is ready for its intended operation. Any ongoing maintenance, access or dismantling requirements should also be documented.


    Successful installation projects are rarely won during the final hours on site. They are usually won much earlier through accurate surveys, practical engineering, controlled modularisation and close coordination between design, fabrication, logistics and installation teams.


    At Evolution Scenic, installation methodology forms part of the build strategy from the beginning. Structures are developed around how they will travel, how they will be lifted and how they will be assembled under real site conditions.


    When scenic structures are designed with installation in mind, deployment becomes safer, faster and more predictable. Installation stops being a challenge to overcome and becomes an integrated part of the complete fabrication process.

  • Recreating Traditional Materials Through Scenic Fabrication

    Image description

    Recreating Traditional Materials Through Scenic Fabrication


    Many cultural, heritage and destination projects seek to capture the character of traditional construction while meeting modern structural, logistical and operational requirements.


    Original materials such as carved stone, aged timber, decorative plasterwork and hand-finished architectural details can be difficult to reproduce using historic construction methods. Their weight, availability, installation time and maintenance requirements may make them unsuitable for temporary environments, exhibition pavilions, heritage festivals or visitor centres.


    Scenic fabrication provides a practical way to bridge these requirements.


    A lightweight structure can reproduce the visual depth of carved masonry. Modern sheet materials can be shaped and finished to resemble historic timber. Sculpted foam, reinforced coatings and specialist paint systems can create architectural details that appear substantial while remaining manageable to transport and install.


    The objective is not simply to copy the surface appearance of a traditional material. Successful heritage-inspired fabrication requires an understanding of how that material was originally formed, assembled and weathered.


    Stone has mass, irregularity and depth. Timber contains grain, joints, tool marks and natural variation. Plaster develops subtle differences in texture and colour. These characteristics must be interpreted carefully if the finished environment is to feel credible rather than decorative.


    The strongest results combine traditional craftsmanship principles with contemporary engineering, digital fabrication and scenic finishing. This allows cultural environments to retain their intended visual character while remaining safe, maintainable and practical to deliver.

    Image description

    Interpreting Traditional Materials and Architecture


    The process begins with research and visual analysis.


    Before a material can be recreated, the fabrication team must understand what makes it recognisable. This usually involves more than selecting a general colour or surface texture.


    A traditional stone wall may contain irregular blocks, recessed joints, chipped edges and areas of accumulated wear. A historic timber door may be defined by its proportions, construction joints, grain direction, ironwork and uneven surface. Decorative plasterwork may contain repeated geometry, hand-worked transitions and minor variations that reveal how it was made.


    Reference material may include architectural drawings, historic photographs, physical samples, site surveys and local construction details. Where cultural accuracy is important, project historians, architects, artists and heritage specialists may also contribute to the review process.

    Scale is one of the first considerations.


    Textures that look convincing on a small sample can become repetitive or exaggerated when applied across a large façade. Stone joints that are too deep may appear theatrical, while timber grain enlarged beyond its natural scale can immediately reveal the artificial surface.


    The relationship between individual elements also matters. Traditional architecture is often defined by how walls, openings, columns, beams, cornices and decorative panels connect.


    Reproducing isolated motifs without respecting the original construction logic can create an environment that contains the correct visual references but still feels inauthentic.


    Scenic interpretation should therefore consider:

    • Architectural proportions
    • Material scale and thickness
    • Traditional joint patterns
    • Carving depth and edge quality
    • Surface irregularity
    • Tool marks and construction details
    • Colour variation
    • Natural wear and weathering
    • Regional decorative language
    • The relationship between structural and ornamental elements


    Cultural authenticity does not always require exact reproduction.


    Some environments interpret a traditional building language rather than recreate one specific historic structure. In these cases, the fabrication team must identify the visual principles that should remain consistent while allowing the construction method to respond to modern requirements.


    This is particularly relevant for heritage festivals, cultural pavilions and destination environments. The scenic structures may need to represent a particular region or period while accommodating temporary foundations, technical equipment, visitor circulation and modern safety requirements.

    Material samples and mock-ups are essential during this stage.

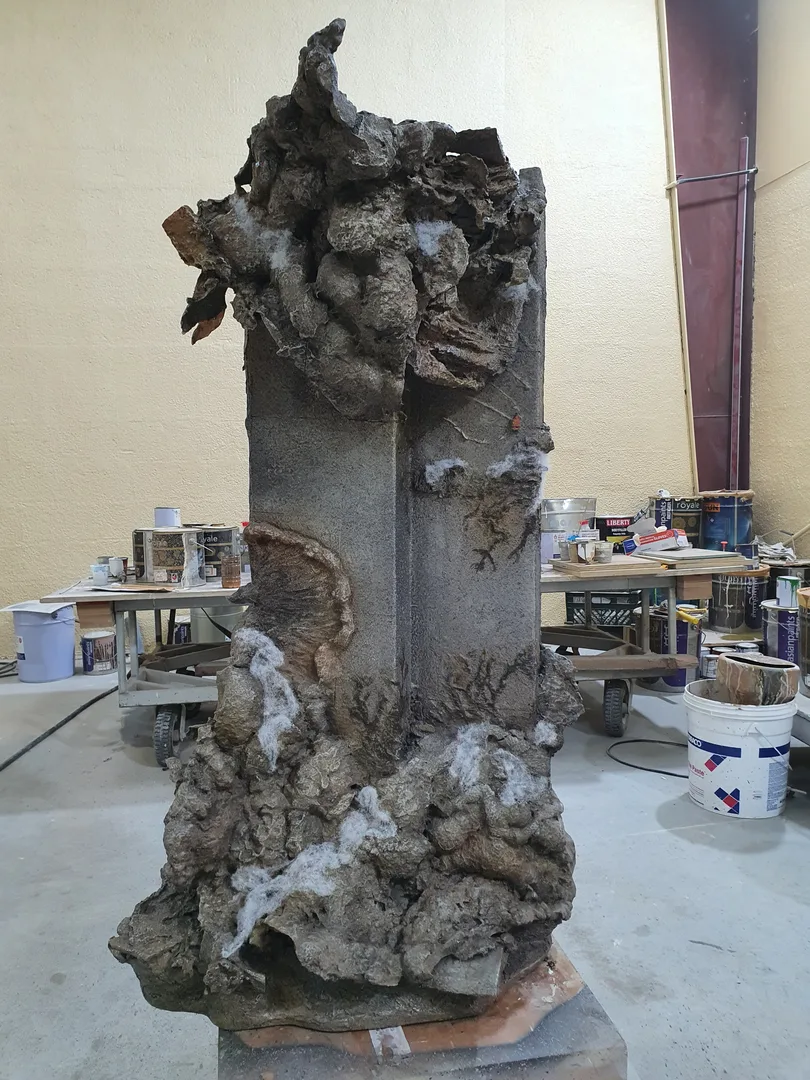

    A small sample can establish colour and texture, while a full-scale section reveals how joints, edges and shadows behave at the intended viewing distance. Larger mock-ups also show whether carving depth, surface variation and ageing techniques remain convincing under natural and artificial lighting.


    Lighting can significantly influence perceived authenticity. Deep textures create stronger shadows, while glossy coatings may make a surface appear synthetic. Samples should therefore be reviewed under conditions that resemble the final environment wherever practical.


    The aim is to define a repeatable visual language before full fabrication begin.

    Image description

    Building Lightweight Scenic Interpretations


    Once the material character has been established, the scenic structure must be engineered around the project’s practical requirements.


    Traditional stone, solid timber and dense plaster can introduce significant weight. Reproducing these materials literally may require substantial foundations, lifting equipment and installation time.


    Scenic fabrication separates visual appearance from structural mass.


    A faux stone façade may be built around a steel or timber frame with lightweight sculpted panels attached to the surface. Faux timber beams may contain hollow internal construction rather than solid sections. Decorative plasterwork can be produced using moulded or CNC-machined components instead of being formed entirely by hand on site.


    This approach reduces weight while allowing the structure to be divided into transportable modules.

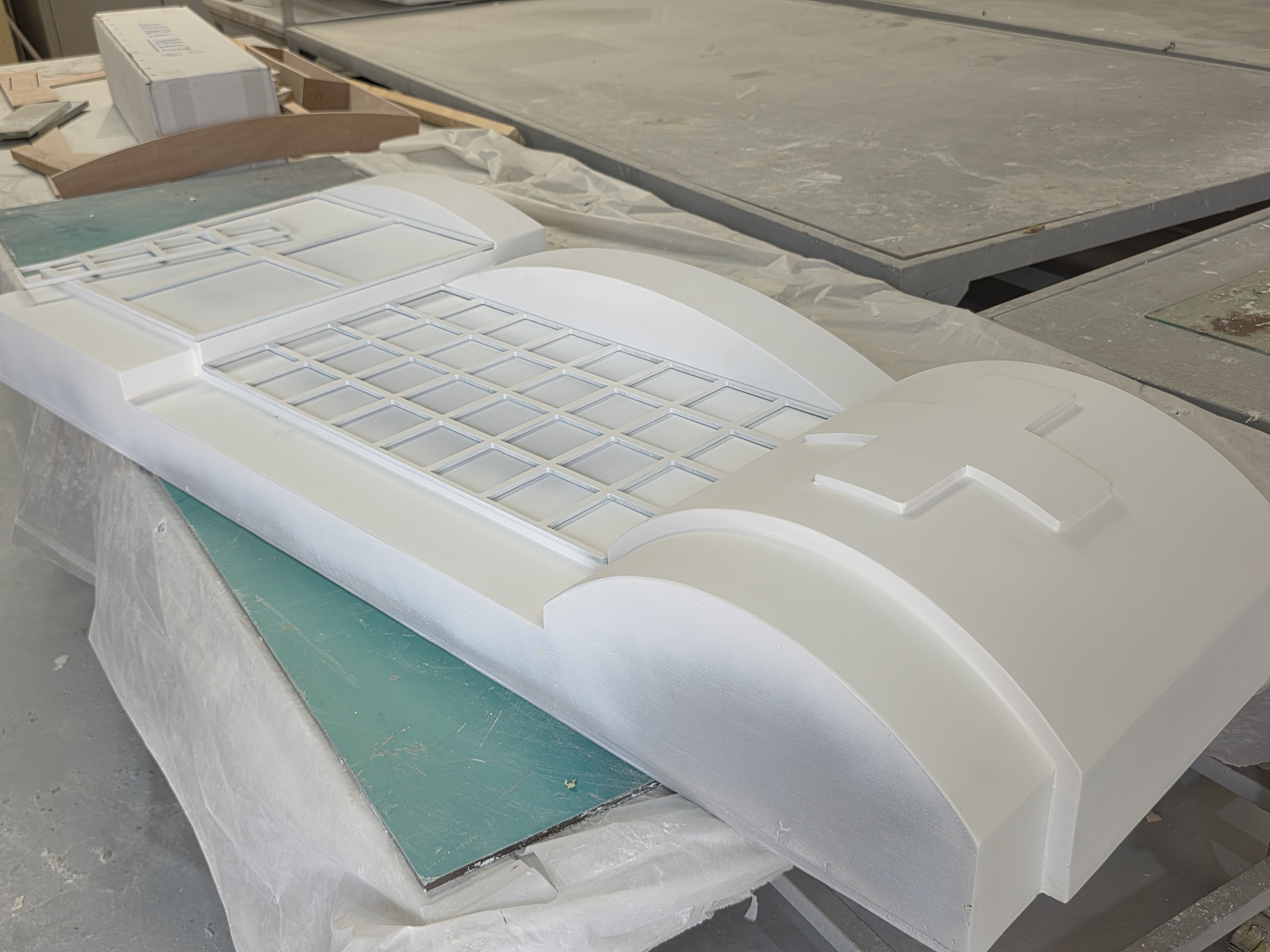

    Image description

    Decorative Plaster and Carved Details


    Decorative plasterwork often involves repeated profiles, geometric patterns, relief panels and architectural mouldings.


    CNC machining allows these elements to be produced accurately from MDF, foam or machinable board. Hand finishing can then soften the precision of the digital process and introduce the slight variation associated with traditional craft.


    Repeated elements may also be cast in GRP, resin or specialist plaster systems. The most suitable material depends on weight, exposure, impact risk and the required finish.


    Large decorative panels require stable backing structures. Thin ornamental surfaces should not be expected to provide structural support, particularly where the installation will be transported or reused.


    Lightweight Structural Systems


    The scenic skin must be supported by a stable internal frame.


    Timber framing is frequently used for temporary walls, pavilions and architectural features because it is easy to modify and provides reliable fixing points. Steel may be introduced where greater height, span or structural capacity is required.


    Aluminium systems can reduce weight for modular or reusable components, although connection design and cladding interfaces must be coordinated carefully.


    Hybrid construction is often the most practical solution. A steel base may provide stability, timber secondary framing may support scenic panels, and lightweight carved surfaces may create the visible traditional material.


    Modules should be designed around transport restrictions, installation access and lifting requirements. Connection points can be concealed within architectural joints, shadow lines or decorative bands.


    Trial assembly helps confirm that repeated patterns align across module boundaries and that the scenic surface continues consistently once the structure is installed.

    Image description

    Scenic Finishing, Ageing and Long-Term Performance


    The final finish determines whether the material interpretation appears credible.


    A technically accurate carving can still look artificial if the colour is too uniform, the sheen is incorrect or the ageing appears randomly applied. Traditional materials rarely contain one flat colour.


    Stone surfaces may include warmer exposed areas, darker recessed joints, mineral staining and dust accumulation. Timber may contain tonal differences between grain, joints, end sections and areas of wear. Plaster may show variations created by hand application, repairs and environmental exposure.


    These effects are usually built through layers.


    A scenic stone finish may begin with a base coat that establishes the overall material colour. Washes and glazes can then add depth within joints and carved recesses. Dry brushing may highlight raised areas, while controlled spattering introduces mineral variation.


    Faux timber may use layered stains, translucent glazes and hand-painted grain. Darker tones can be worked into splits and recessed details, while lighter dry-brushed layers suggest worn or exposed fibres.


    Ageing should follow a logical pattern.


    Weathering develops differently across vertical walls, horizontal ledges, exposed corners and protected recesses. Water marks tend to follow gravity. Dust collects on upward-facing surfaces. High-contact areas may appear smoother or lighter.


    Randomly applying dark paint across a surface may create visual activity, but it does not necessarily create believable age.


    Scenic artists therefore consider how the material would have been used and exposed over time. This gives the ageing process a physical logic.


    Surface sheen is equally important.


    Historic stone and aged plaster are usually matt or softly reflective. Excessively glossy protective coatings can undermine the finish even when they improve durability. The selected topcoat should protect the surface without changing its approved character.


    Durability requirements depend on the environment.


    A temporary cultural pavilion may only need to perform for several weeks but could still experience outdoor heat, dust, wind and repeated public contact. A museum or visitor centre installation may operate for years and require frequent cleaning.


    High-contact corners, plinths and door surrounds may need stronger substrates or reinforced coatings. Elevated decorative surfaces can often use lighter systems because they are less exposed to impact.


    Outdoor structures require careful attention to ultraviolet exposure, moisture, thermal movement and drainage. Scenic coatings should not be expected to compensate for poor construction detailing.


    Edges must be sealed, joints must accommodate movement and water should not be allowed to collect behind decorative panels. Metal frames require suitable corrosion protection, while timber-based materials need appropriate sealing for the expected environment.


    Maintenance should also be planned from the beginning.


    Removable panels allow damaged areas to be repaired or replaced without dismantling the complete environment. Finish schedules should record base colours, glazes, protective coatings and application techniques so future repairs can be matched accurately.


    Retaining samples is particularly useful for long-term installations. A written paint code may not capture the complete appearance of a layered scenic finish.


    The finished environment should also be inspected after installation. Transport, lifting and site assembly can create small cracks, abrasion or alignment changes that were not visible in the workshop.


    Final scenic touch-ups should restore continuity across module joints and connection points without creating noticeably newer areas.


    At Evolution Scenic, recreating traditional materials is treated as a coordinated fabrication process rather than a surface treatment applied at the end.


    Research, engineering, carving, structural framing, digital fabrication and specialist finishing all contribute to the result. The visible material must remain convincing, but it must also be practical to transport, install, maintain and operate.


    The strongest heritage-inspired environments respect the visual language of traditional construction without being restricted by its physical limitations.


    When modern fabrication methods are used carefully, they allow stone, timber and decorative architectural forms to be interpreted with less weight, greater control and improved serviceability.

    The finished environment may appear traditional.


    The methodology behind it is entirely contemporary.


  • Al Burda Festival and Awards Show – Scenic Fabrication and Technical Design, Abu Dhabi (2018)

    Evolution Scenic main stage and screen surrounds for Al Burda Festival Abu Dhabi.

    Cultural festivals require environments that can support many different forms of engagement while maintaining a consistent creative identity. In November 2018, the Ministry of Culture and Knowledge Development hosted the inaugural Al Burda Festival and Awards Show at Warehouse 421 and the NYU campus in Abu Dhabi.


    The event brought together artists and visionaries from across the MENA region for knowledge sharing, interactive workshops, art exhibitions and an evening performance by international artists at the NYU main theatre.


    Evolution Scenic provided technical design, structural development and scenic fabrication for the festival. The scope included scenic elements for the main stage, workshop spaces and art galleries, alongside a custom temporary structure for the main plenary and bespoke branded features throughout the event.


    The Solution


    Evolution Scenic developed detailed technical construction drawings and established the fabrication requirements necessary to transform the creative brief into buildable scenic elements.


    Materials were selected according to the visual, structural and functional needs of each component. This ensured the fabricated elements achieved the required appearance while remaining suitable for their intended environments and uses.


    For the main plenary, the team constructed a custom temporary event structure that combined structural performance with considered architectural detailing. Additional scenic elements were fabricated for the main stage, workshop spaces and art galleries, creating distinctive environments for the festival’s different programme areas.


    Bespoke branded features, including signage and backdrops, were also produced to strengthen the festival’s identity and maintain visual consistency across the guest experience.

    Delivery Highlights


    • Technical design and structural development
    • Detailed technical construction drawings
    • Fabrication planning and material specification
    • Scenic fabrication for the main stage
    • Scenic environments for workshop spaces
    • Fabricated elements for art galleries
    • Custom temporary structure for the main plenary
    • Bespoke branded features
    • Event signage and backdrops
    • Delivery across Warehouse 421 and the NYU campus
    • Support for the inaugural Al Burda Festival and Awards Show


    Outcome


    The completed scenic installation supported the festival’s varied cultural programme while maintaining a cohesive visual identity across its principal environments.


    Through detailed technical development, considered material selection and specialist fabrication, Evolution Scenic translated the creative brief into functional structures and scenic elements for the main stage, plenary, workshops and galleries.


    The project demonstrated the team’s ability to deliver coordinated scenic environments for a multi-venue cultural event, combining structural requirements with the artistic standards expected of an internationally focused festival and awards programme.

    Project Ecosystem


    Evolution Scenic – Technical design, construction drawings, structural development, material selection, temporary structures, scenic fabrication, branded elements, signage and backdrops.

  • Barzatkum – Bespoke Scenic Fabrication and Donor Installations, Abu Dhabi (2019)

    Barzatkum hosted at Sandooq Al Watan

    Donor recognition events require environments that celebrate individual contributions while communicating a wider sense of shared purpose. In March 2019, Sandooq Al Watan hosted Barzatkum at Qasr Al Bahr in Abu Dhabi to honour existing donors and encourage further contributions towards sustainable development through social responsibility.


    Evolution Scenic created a sophisticated event environment centred on recognition, participation and storytelling. The scenic scope included the main stage setting, an intricate donor gallery, an interactive pledge tree, branded photography backdrops and event signage.


    Each element was developed to support the programme while visually expressing the collective impact of Sandooq Al Watan’s donors and reinforcing the organisation’s vision for future initiatives.

    Evolution Scenic decorative screen panels integrated into the Barzatkum main stage architecture

    The Challenge


    The event environment needed to recognise existing donors, communicate Sandooq Al Watan’s achievements and encourage further philanthropic participation without losing the sense of occasion expected at an exclusive gathering.


    The scenic elements also needed to perform different roles within one cohesive environment. The main stage had to provide an effective setting for speeches and presentations, while the donor gallery and pledge tree needed to transform donor recognition into meaningful visual installations.


    Branding, symbolism and functionality therefore had to be carefully balanced across the stage, gallery, interactive feature and photography areas.

    The Solution


    Evolution Scenic designed and fabricated a refined main area featuring a scenic stage backdrop for speeches and presentations. The backdrop combined a strong visual presence with the functional requirements of the event programme.


    A bespoke donor gallery was created using crystal raindrop pendants engraved with sponsor logos. Suspended as a collective installation, the individual pendants represented the combined impact of the donors while giving each contributor visible recognition within the event environment.


    The team also created an interactive pledge tree with donor logos presented as leaves. Positioned as a central feature, the installation provided a visual expression of collective support and encouraged guests to make further pledges.


    Custom photography backdrops and signage extended the event identity across additional guest-facing areas and created dedicated opportunities for branded event photography.

    Delivery Highlights


    • Scenic production for Barzatkum at Qasr Al Bahr
    • Main event area and stage environment
    • Scenic stage backdrop
    • Setting for speeches and presentations
    • Bespoke donor gallery
    • Crystal raindrop pendants
    • Sponsor logos engraved onto individual pendants
    • Suspended donor-recognition installation
    • Interactive pledge tree
    • Donor logos displayed as leaves
    • Custom photography backdrops
    • Bespoke event signage
    • Coordinated scenic and branding elements


    Barzatkum temporary architecture combining stage fabrication, display joinery and bespoke scenic installations.

    Outcome


    Barzatkum brought donors together within an environment designed to communicate recognition, sophistication and shared purpose.


    The donor gallery transformed individual sponsor identities into a unified art installation, while the pledge tree encouraged continued participation through a clear and engaging visual concept. The main stage, photography areas and signage supported the event programme and maintained a consistent identity throughout the venue.


    Through detailed fabrication and carefully considered symbolic features, Evolution Scenic created an event environment that celebrated existing contributions while supporting Sandooq Al Watan’s message of future philanthropic engagement.

    Evolution Scenic MDF and timber pledge tree with branded donor leaf display elements

    Project Ecosystem

    Evolution Scenic – Scenic development, stage backdrop fabrication, donor-gallery installation, engraved crystal pendants, interactive pledge tree, photography backdrops and event signage.

  • Culture Summit – Multi-Venue Scenic Fabrication & Technical Event Design, Abu Dhabi (2019)

    Multi-Venue Scenic Fabrication, Staging and Branded Installations for Culture Summit Abu Dhabi

    Multi-venue cultural forums require scenic production to adapt to very different architectural environments while maintaining a consistent event identity. For the 2019 Culture Summit in Abu Dhabi, Evolution Scenic delivered technical design, scenic fabrication and installation support across several major cultural locations.


    Held under the theme “Cultural Responsibility & New Technology,” the summit brought together 450 delegates from 90 countries for panels, performances and workshops. The programme extended across Manarat Al Saadiyat, the Cultural Foundation, Louvre Abu Dhabi and locations on Saadiyat Island, requiring scenic solutions that could respond to each venue while still contributing to one coherent event experience.

    Multicoloured printed stage surface fabricated for the Culture Summit presentation space.

    The Challenge


    The Culture Summit needed to operate across multiple venues with different layouts, architectural characteristics and operational restrictions.


    Each location required scenic and staging elements appropriate to its own environment, while the overall event still needed to feel visually connected.


    The project also required detailed technical development, including construction drawings and material specifications, so that the scenic elements could be fabricated accurately and integrated safely within the venues.


    HSE requirements, venue-specific restrictions and multi-location logistics added further complexity, particularly because delivery and installation needed to be coordinated across several active sites.

    Evolution Scenic multi-venue scenic fabrication combining staging, branding, furniture and décor.

    The Solution


    Evolution Scenic developed detailed construction drawings and material specifications to support the fabrication and installation of the required scenic elements.


    Bespoke staging, scenic backdrops and branded installations were fabricated for the different summit environments, with each element tailored to suit the architectural character and operational requirements of its venue.


    Custom signage and branded scenic features were also produced to maintain a consistent identity across the wider event.


    Furniture and décor were sourced and installed to support both functionality and the visual treatment of each space.


    Across the multi-venue programme, Evolution Scenic coordinated installation around HSE protocols, venue restrictions and logistical requirements, ensuring the different scenic packages were delivered consistently across the summit locations.

    Custom scenic construction supporting Culture Summit presentations and cultural performances in Abu Dhabi.

    Delivery Highlights


    • Scenic production for Culture Summit 2019.

    • 450 delegates from 90 countries.

    • Theme: Cultural Responsibility & New Technology.

    • Multi-venue delivery across Abu Dhabi.

    • Manarat Al Saadiyat.

    • Cultural Foundation.

    • Louvre Abu Dhabi.

    • Saadiyat Island locations.

    • Detailed construction drawings.

    • Material specifications.

    • Bespoke staging.

    • Custom scenic backdrops.

    • Branded installations.

    • Custom signage.

    • Furniture and décor sourcing.

    • Venue-specific scenic integration.

    • HSE coordination.

    • Management of venue restrictions.

    • Multi-location logistics.

    • Delivery and installation.

    Evolution Scenic circular stage with colourful geometric floor graphics at Culture Summit Abu Dhabi.

    Outcome


    The completed Culture Summit environment provided a consistent visual framework across several very different cultural venues.


    The staging, scenic backdrops, branding, furniture and décor were adapted to the character of each location while maintaining continuity across the wider event.


    The project demonstrates Evolution Scenic’s ability to deliver technically developed scenic packages across complex multi-venue programmes, where fabrication, logistics, HSE requirements and architectural sensitivity all need to be managed simultaneously.

    Evolution Scenic freestanding signage and scenic graphics for Culture Summit Abu Dhabi.

    Project Ecosystem


    Evolution Scenic – Technical design, construction drawings, material specifications, scenic fabrication, staging, branded installations, signage, furniture and décor, venue coordination, HSE integration, logistics, delivery and installation.

    Image description
