  • Why Temporary Structures Need Permanent Thinking

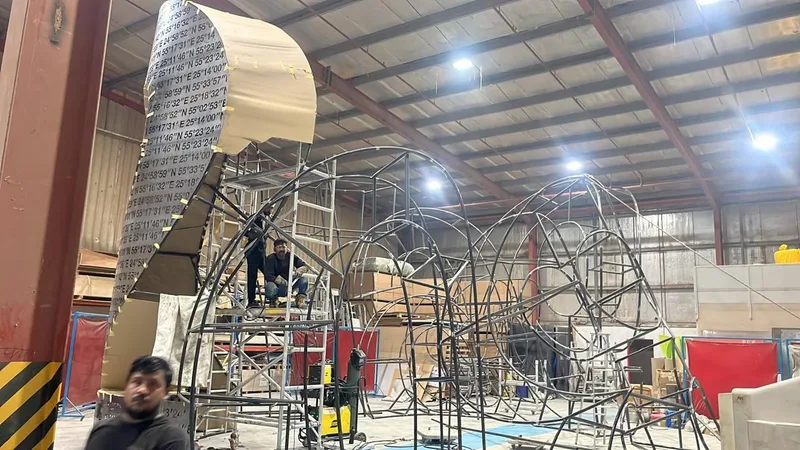

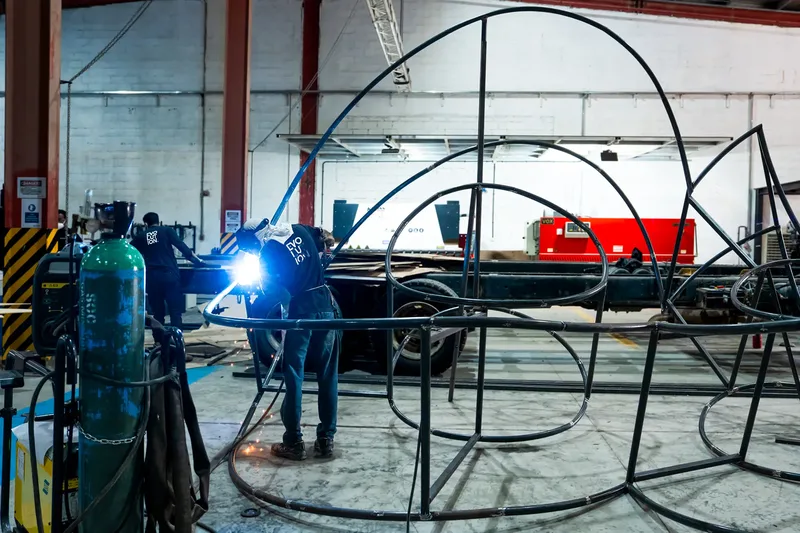

    Evolution Scenic temporary scenic frame being fabricated and checked in the workshop

    Temporary structures may have short lifespans, but their fabrication demands the same disciplined thinking applied to permanent construction.

    Why Temporary Structures Need Permanent Thinking

    One of the biggest misconceptions surrounding temporary environments is that a short lifespan somehow means they require less engineering, less planning or less attention to detail. In scenic fabrication, the opposite is often true.

    A structure that will exist for only a few days may still need to perform to an extremely high standard while dealing with a far more compressed and demanding project lifecycle.

    Temporary is therefore a description of how long something will remain in place, not the standard to which it should be designed. Whether Evolution Scenic is fabricating an exhibition environment, brand activation, temporary architectural structure or touring installation, the structure still needs to be safe, stable, accurately manufactured and practical to install.

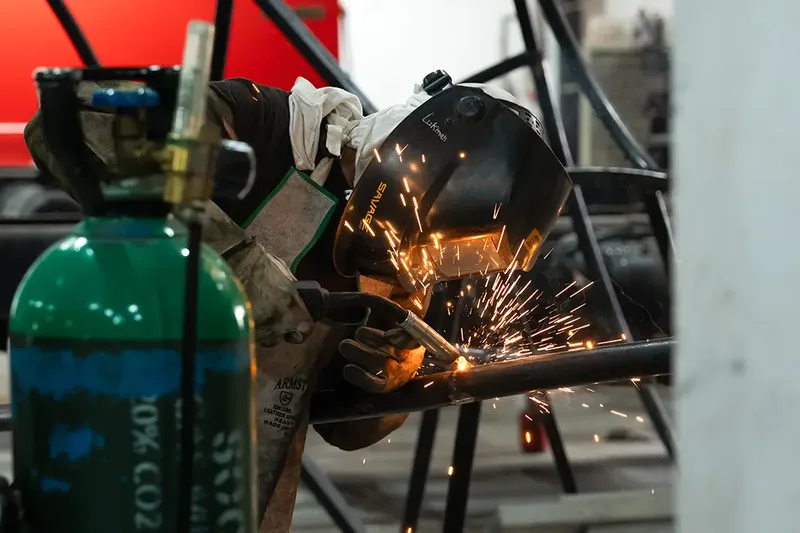

    Close detail of engineered connection hardware within a temporary scenic structure

    Reliable, repeatable connections are central to structures that must be assembled, operated and dismantled within compressed programmes.

    Temporary Does Not Mean Simple

    A temporary structure passes through an unusually concentrated lifecycle.

    It is fabricated in the workshop, inspected, packed, transported, unloaded, installed, operated, dismantled and removed, sometimes within the space of only a few weeks. On particularly fast projects, several of these stages can happen within days of one another.

    At the same time, temporary environments are frequently expected to achieve the same visual quality as permanent interiors. Exhibition walls still need clean junctions. Branded structures still need accurate geometry.

    Feature elements still require high-quality scenic finishes. The difference is that these elements may also need to be lightweight, modular, transportable and capable of being assembled during a tightly controlled installation window.

    Engineering for Speed, Stability and Low Weight

    One of the central challenges in temporary scenic engineering is balancing weight against structural performance. Structures need to be light enough to transport and handle efficiently, but sufficiently rigid to remain stable once installed.

    Depending on the application, this may involve considering crowd interaction, suspended elements, integrated equipment, wind exposure, vibration or loads created by cladding and finishes.

    The connection system becomes particularly important. Bolted connections, pinned joints, locating plates, captive fixings and pre-drilled interfaces can allow large structures to be assembled rapidly without sacrificing accuracy.

    Good temporary engineering avoids relying on crews to make components fit on site. The aim is to create predictable connections that naturally locate components in the correct position.

    Designing the Installation Before Fabrication

    Experienced scenic teams think about installation long before the structure reaches the workshop floor. Module sizes may be determined by loading dock dimensions, passenger or goods lifts, door openings, vehicle capacities or the amount of space available for manoeuvring components inside the venue.

    The sequence of assembly must also be considered. Structural frames may need to be installed before finished skins can be applied. Certain fixings need to remain accessible until adjacent modules are secured. Decorative panels may conceal structural connections, meaning they must be removable or installed at carefully planned stages of the build.

    Dismantling should be considered at exactly the same time. If a structure needs to leave a venue overnight, the team needs to know how finishing panels are removed, where lifting or handling points are located and which connections can be released first without making the remaining structure unstable. A good temporary build methodology works just as effectively in reverse.

    Venue restrictions introduce another layer of complexity. Floors may need protection. Drilling into existing surfaces may be prohibited. Structural loads may need to be distributed carefully. Fire requirements, escape routes, working-at-height controls, noise restrictions and limited installation hours can all influence how the scenic structure is developed.

    Modular Construction and Reusability

    Modular construction is one of the most effective approaches to temporary architecture. Instead of treating every structure as a single assembly, fabrication teams can divide it into manageable sections that are easier to manufacture, transport, install and replace.

    For reusable structures, the modular strategy becomes even more important. A core steel or aluminium frame can potentially support multiple configurations while interchangeable scenic skins, graphic panels or architectural finishes create a different appearance for each deployment. This approach is particularly valuable for touring activations, exhibition systems and repeat brand environments.

    However, reuse requires more than making something strong. Edges need to withstand repeated handling. Fixings need to survive multiple assembly cycles. Decorative surfaces may need replaceable sacrificial layers. Components need to be clearly labelled, packed and stored so that they can be identified months later. Hardware needs inspection and worn components need to be replaceable without rebuilding the entire structure.

    Touring Environments

    Touring environments introduce an additional design consideration: transport geometry. The dimensions of modules may be influenced by truck bodies, containers, pallets, flight cases or available loading equipment.

    A structure that performs perfectly once assembled but occupies unnecessary transport volume can become expensive and inefficient to tour.

    Different venues can also introduce different tolerances. Floors may not be perfectly level. Access conditions may change.

    Installation spaces can vary slightly from drawings. Adjustable feet, controlled tolerances, replaceable interface plates and carefully considered junction details allow touring structures to accommodate these differences without compromising the finished appearance.

    Digital manufacturing is particularly valuable here. CNC routing and other digitally controlled processes allow repeated components to be produced consistently from the same manufacturing information.

    If a damaged component needs replacement during a touring programme, an accurately developed digital production file can make reproduction significantly easier.

    Materials, Finishes and Integrated Technology

    Temporary construction does not automatically mean inexpensive materials. Material selection needs to respond to what each component actually needs to achieve. Plywood, MDF, aluminium, steel, composite sheet materials, foams and specialist scenic products all have different advantages depending on span, weight, finish quality, fire performance and expected handling.

    Scenic finishes also need to survive more than the finished installation.

    A painted surface may be handled in the workshop, wrapped for transport, loaded into a vehicle, carried through a venue and assembled alongside other components. Corners, edges and high-contact areas therefore require particular attention if the finish is expected to remain clean once the installation is complete.

    Technology integration requires the same level of planning. Screens, lighting, speakers, sensors and other equipment may need secure mounting points, ventilation, power distribution and cable routes. Access panels need to remain reachable for maintenance. Technology should be integrated into the scenic structure rather than treated as something that can simply be added once everything else has been built.

    Logistics Are Part of Fabrication

    For temporary environments, logistics are closely connected to fabrication methodology. A structure can be beautifully manufactured and still become difficult to install if components arrive in the wrong order, fixings cannot be located quickly or large modules are packed behind items that need to be installed first.

    Workshop dry-fitting is one of the most effective ways to reduce this risk. Assembling key sections before dispatch allows the fabrication team to check alignment, tolerances, finishes and connection details while workshop tools and machinery are still available. Numbering and coding the modules also gives the installation team a clear system to follow once the structure reaches site.

    Packing can then follow the installation sequence. Structural elements required first can remain accessible, while finished components are protected until needed. Hardware kits can be organised by module or assembly stage. The result is fewer unnecessary movements on site and less time spent searching for components during a limited installation window.

    Removal requires the same consideration. Temporary structures may need to return to the workshop, travel to another venue, enter storage or be separated into reusable and non-reusable materials. Protective packaging, transport routes and storage requirements should therefore be planned before the structure is ever delivered.

    Permanent Thinking for a Temporary Lifespan

    Permanent thinking does not mean constructing temporary environments using permanent-building methods. It means applying the same discipline to structural behaviour, detailing, material selection and buildability while also designing specifically for transportation, fast installation and eventual removal.

    In many ways, temporary architecture requires greater precision because there is less time available to solve problems on site. Connection systems need to work immediately. Modules need to align correctly. Finishes need to arrive protected. Technology needs to connect as intended. Installation teams need a clear sequence rather than relying on improvisation.

    The most successful temporary scenic environments are therefore designed around their complete lifecycle. From technical development and workshop fabrication through transport, installation, operation and dismantling, every stage affects the next.

    The structure may only exist for a few days, but the thinking behind it needs to account for everything that happens before, during and after those days.

  • Why We Sometimes Say No To Creative Ideas

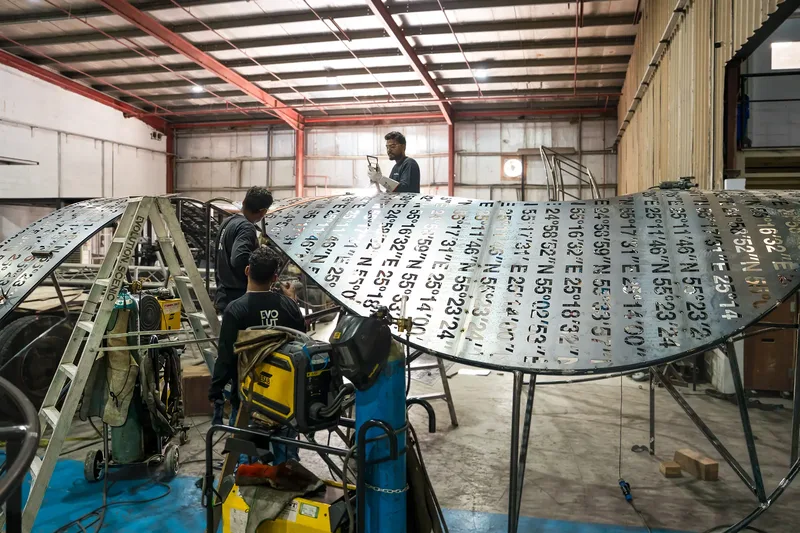

    Evolution Scenic fabricators assembling a large bespoke scenic feature with complex geometry

    Challenging projects bring together engineering, craftsmanship and practical problem-solving.

    Why We Sometimes Say No To Creative Ideas

    Contrary to popular belief, fabrication teams enjoy ambitious ideas.

    Complex structures, unusual geometry and concepts that have never been built before are often some of the most rewarding projects a workshop can undertake. They force designers, engineers, carpenters, metal fabricators and scenic artists to solve problems that do not have an obvious answer.

    So why do fabricators sometimes say no?

    Usually, it is not because the idea cannot be built.

    More often, it is because the way the idea has initially been proposed introduces engineering, transportation, installation or operational risks that outweigh the benefits of building it in that form.

    A No Is Usually A Risk Assessment

    Scenic fabrication exists in the space between creative ambition and physical reality.

    A structure may need to support significant loads while remaining visually lightweight. It may need to stand several metres high while being installed without fixing into the venue floor.

    It may need to move, rotate or travel on a vehicle while maintaining stability. It may need to appear monolithic while actually being manufactured as dozens of separate components.

    Each of those requirements introduces engineering questions that are not always visible in the original concept.

    Load paths, deflection, bracing, connection details, centre of gravity, lifting points and wind exposure can all affect whether a scenic structure will behave as intended.

    Temporary structures introduce another layer of complexity because they also need to be assembled, dismantled, transported and sometimes reused.

    A connection that works perfectly for a permanent installation may be completely impractical when a structure needs to be installed during a short overnight access window.

    This is why an experienced fabrication team may challenge the proposed solution even when they strongly support the creative idea behind it.

    The distinction is important.

    The concept may be perfectly achievable.

    The first construction method may not be.

    Buildability Is Part Of Creative Development

    A render can show almost anything.

    Fabrication development begins when that image has to become a physical object.

    At this stage, dimensions become components, surfaces become material build-ups and apparently simple forms become networks of frames, connections, brackets, panels and finishes.

    Technical drawings are critical to this process. Sections reveal available structural depth.

    Connection details establish how modules will join. Material specifications determine weight and behaviour. Tolerances establish whether hundreds of individually manufactured parts will actually align when assembled.

    This is also where CNC machining, scenic carpentry, metal fabrication and finishing methods begin to influence the design.

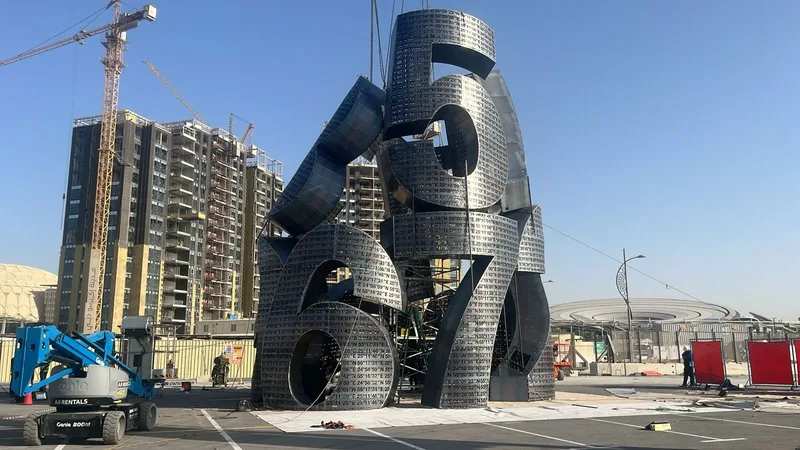

    A complicated curved form, for example, may be perfectly achievable but inefficient if every component needs to be manually set out. Developing the geometry for CNC routing can make the same feature faster to manufacture, more accurate and considerably easier to reproduce.

    The earlier these conversations happen, the more creative freedom usually remains.

    Discovering a buildability issue while reviewing technical drawings may require a minor change.

    Discovering the same problem while a structure is being installed on site can require a major compromise.

    Venue Constraints Can Change The Answer

    Sometimes the structure itself is not the problem.

    The building around it is.

    Loading doors, goods lifts, corridors, ceiling heights and turning spaces can determine the maximum size of every scenic module before fabrication even begins.

    A six-metre-high feature wall may fit comfortably into the final installation space but still be impossible to move through the venue as a single assembly.

    The solution is not necessarily to reduce the height.

    The better solution may be to divide the wall into transportable modules with engineered connections, alignment systems and concealed joints so that it still appears continuous after installation.

    Venue restrictions can also affect structural methodology.

    Floor loading limits may restrict ballast. Rigging rules may prevent suspension from certain locations. Existing finishes may prohibit drilling.

    Hot-work restrictions may limit on-site welding. Noise restrictions may reduce the amount of fabrication that can realistically take place during installation.

    These conditions all influence what should happen in the workshop.

    Where site fabrication is restricted, more work may need to be completed during pre-assembly. Components can be dry-fitted, labelled and tested before delivery so that installation becomes primarily an assembly process rather than a construction exercise.

    Good scenic engineering therefore considers the venue before manufacturing begins.

    Transport Shapes What Gets Fabricated

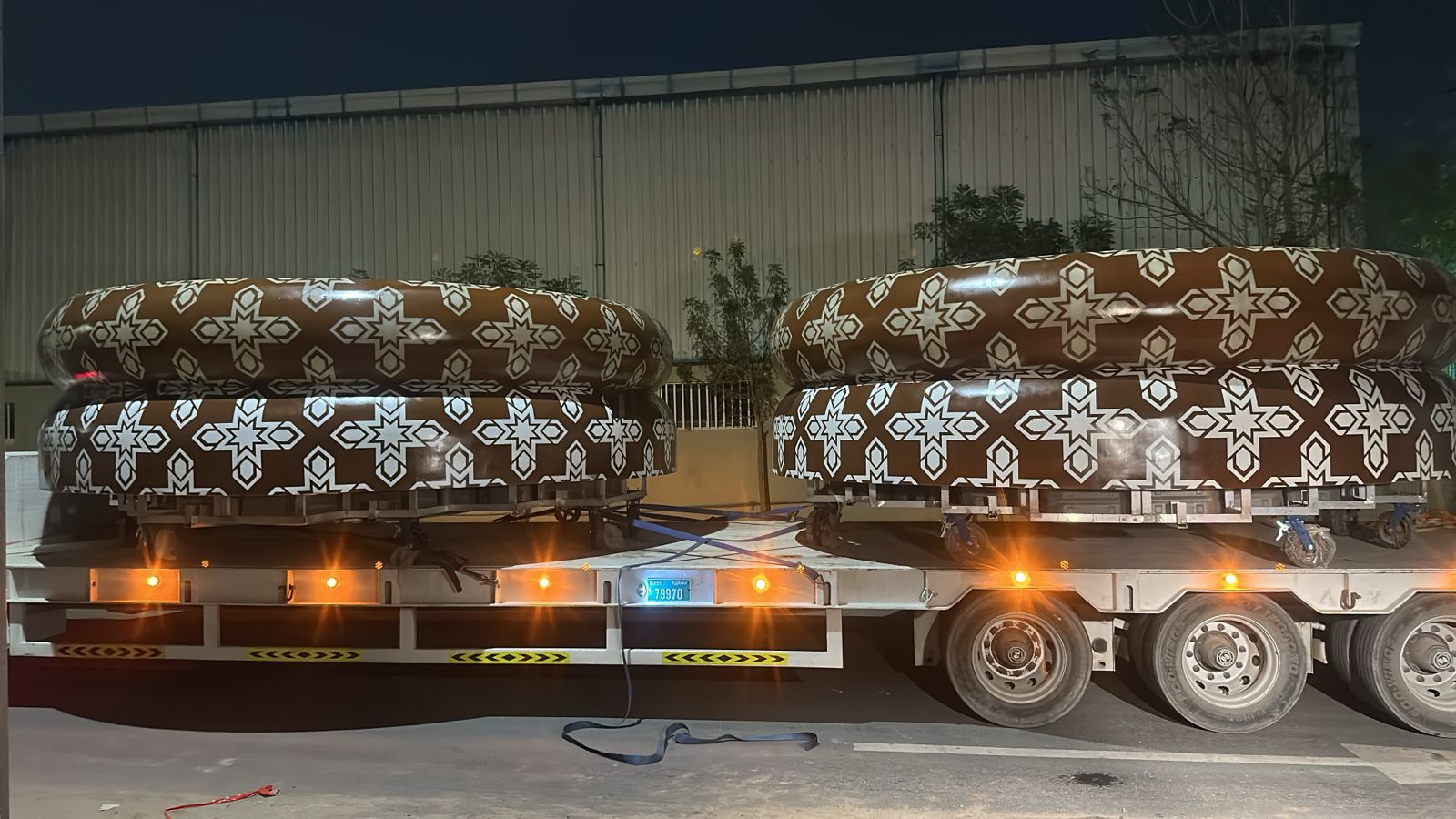

    Large scenic structures also need to leave the workshop.

    This sounds obvious, but transportation is one of the most common reasons a technically achievable design needs further development.

    Vehicle dimensions, container sizes, road restrictions, loading methods and handling equipment all affect component size.

    A scenic structure that measures eight metres in one direction may eventually need to be fabricated as four separate modules simply because that is the most practical way to transport it safely.

    Designing those break points intelligently is part of the fabrication process.

    Connections need to remain accessible. Finished surfaces require protection. Modules need suitable lifting or handling points. Packing sequences need to consider which elements will be required first during installation.

    A strong modular strategy can dramatically improve both logistics and site efficiency.

    Large structures can be assembled completely within the workshop, checked for alignment, dismantled into transportable sections and then reassembled on site using the same predetermined connections.

    What appears to be one enormous object in the finished environment may therefore have been designed from the beginning as a carefully coordinated kit of parts.

    The Best Response Is Often An Alternative

    Experienced scenic teams rarely want the conversation to end with the word “no”.

    The more useful response is:

    “What if we did it this way instead?”

    Sometimes the alternative involves changing the structure while leaving the visible design untouched.

    Sometimes it involves changing the material.

    A feature designed to look like carved stone, for example, does not necessarily need to be manufactured from a heavy solid material. A lightweight internal structure combined with carved or CNC-produced scenic surfaces and an appropriate finish may achieve the same visual character while reducing weight, handling requirements and structural demand.

    The same principle applies to steelwork.

    Steel may provide excellent strength, but using it everywhere can introduce unnecessary weight. Depending on the structure, a combination of steel, aluminium, timber, plywood, composite materials and lightweight scenic components may produce a more efficient solution.

    Material selection is therefore rarely based on appearance alone.

    Weight, strength, fabrication method, fire performance, finish quality, durability, transportation and installation all need to be considered together.

    Moving structures make these decisions even more important.

    Consider a tall scenic feature mounted onto a moving platform or vehicle. The creative objective may be to create maximum height and visual impact, but placing too much weight high above the base can raise the centre of gravity and reduce stability.

    The answer does not have to be a shorter structure.

    The lower portion might use a stronger structural chassis while the upper scenic elements are redesigned using lightweight materials. Elements may fold, detach or telescope for transportation before being secured in their operating position.

    The creative silhouette remains.

    The engineering underneath it becomes considerably more intelligent.

    Why Collaboration Matters

    The relationship between creative and technical teams works best when neither side treats the other as an obstacle.

    Creative teams should be able to propose ambitious ideas without designing every connection or fabrication detail themselves.

    Equally, fabrication teams should not simply reject an idea because the first version is difficult to manufacture.

    Their role is to understand the intention behind the concept and determine how that intention can be translated into something buildable.

    That requires asking the right questions.

    How will it stand?

    How will it be transported?

    How does it enter the venue?

    Where can it be lifted?

    What happens if the floor cannot be fixed into?

    Can someone reach the connection during installation?

    What happens to the finished surface when two modules are joined?

    Can the structure be dismantled without destroying it?

    These questions are not designed to restrict creativity.

    They reveal the practical conditions that allow creativity to survive fabrication.

    When technical teams become involved early, potential problems can often be converted into design opportunities.

    A required structural joint can become part of a panel rhythm. A transport break can be concealed behind a graphic feature. A necessary support can be incorporated into the visual geometry.

    The technical solution begins to support the design rather than compete with it.

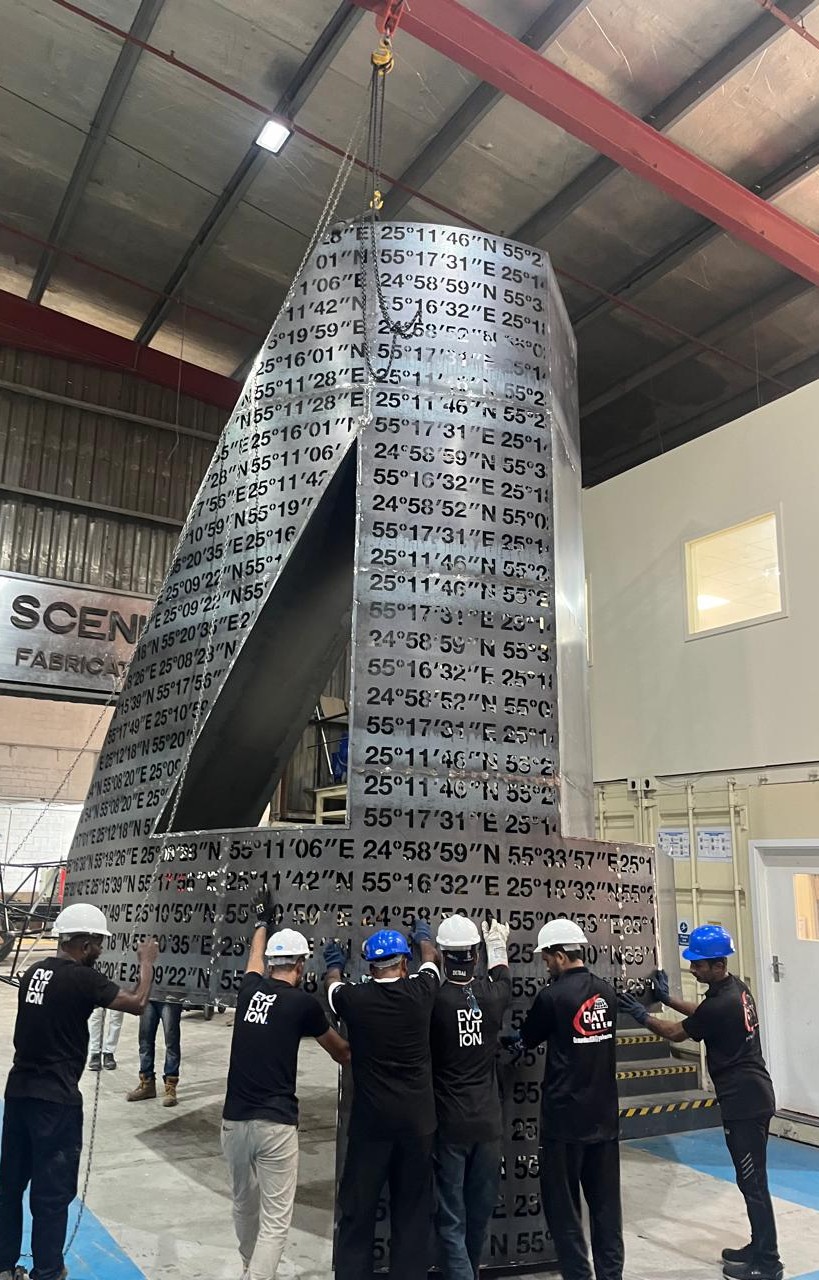

    Creative and technical teams reviewing scenic assembly during workshop dry-fit

    The strongest solutions emerge when creative intent and fabrication knowledge develop together.

    A Better Idea Is Often The Engineered Version

    The first creative idea is not always the strongest version of the project.

    Sometimes it needs to be challenged.

    Not because the ambition is unrealistic, but because there may be a safer, lighter, faster or more elegant way of achieving the same result.

    At Evolution Scenic, this is where technical drawings, scenic engineering, material selection, workshop testing and fabrication experience become part of the creative process.

    The objective is not to reduce ambitious ideas until they become easy to build.

    It is to understand which parts of the idea are essential, identify the practical constraints around them and develop a fabrication methodology capable of delivering the intended result.

    Sometimes that means saying no to the first solution.

    More importantly, it means finding a better way to say yes.

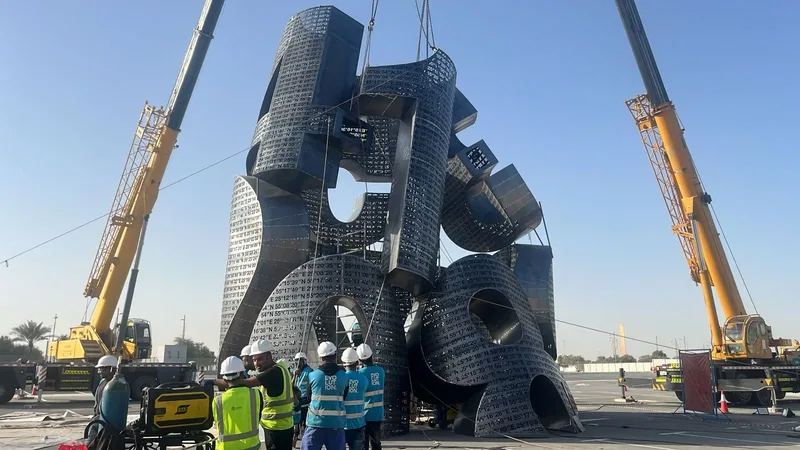

    Completed Evolution Scenic environment combining engineered structure and refined scenic finishes

    Sometimes saying no to the first method is how a stronger version of the idea gets built.

  • Why CNC Production Matters In Scenic Fabrication

    Image description

    Why CNC Production Matters In Scenic Fabrication

    Modern scenic fabrication increasingly relies on digital manufacturing to achieve levels of accuracy, consistency and production efficiency that would be difficult to maintain through traditional methods alone.

    Whether the project involves an exhibition environment, a large branded installation, a retail pop-up or a highly detailed cultural structure, CNC production gives fabrication teams a controlled way to translate complex design information into physical components.

    What makes CNC particularly valuable is the connection it creates between design development and manufacturing. Geometry produced during the CAD and technical drawing stages can be prepared directly for production, allowing components to be cut, shaped and repeated with a high degree of accuracy. This reduces unnecessary interpretation on the workshop floor and helps ensure that what has been technically developed is reflected in the parts being manufactured.

    Image description

    From CAD To Machine-Ready Production

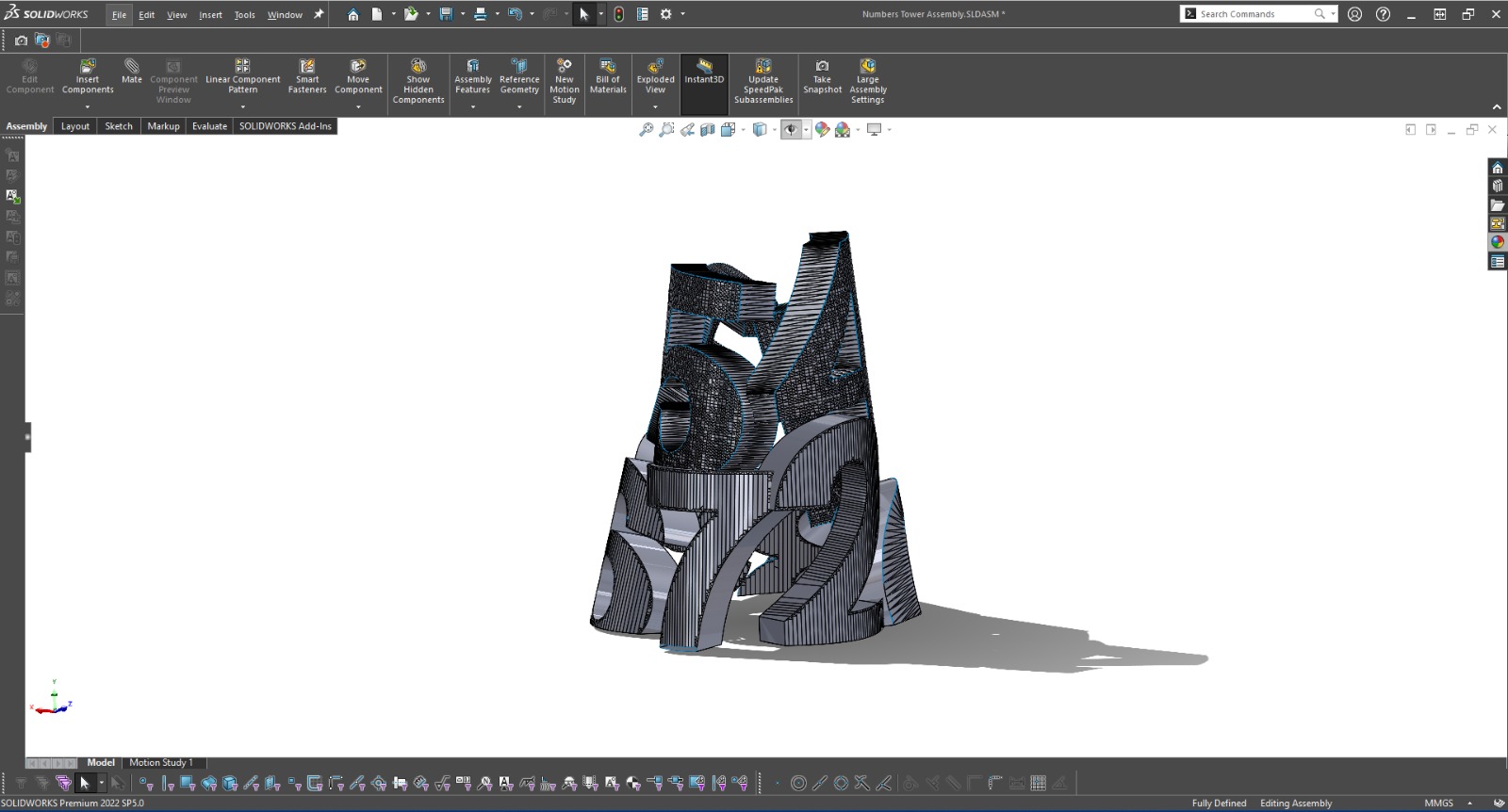

    The CNC process begins long before a cutting tool touches material. Reliable production depends on clean CAD geometry, clearly defined dimensions and an understanding of how each component will eventually be assembled.

    Fabricators need to consider material thicknesses, joint locations, edge conditions, fixing methods and realistic machining tolerances while preparing the digital files. A visually correct model is not automatically a production-ready model.

    Once the geometry is resolved, components can be nested onto sheets and translated into machine toolpaths. Nesting becomes particularly important when significant quantities of plywood, MDF, acrylic or composite sheet material are involved, because efficient layouts can reduce material waste considerably.

    Tool diameter, cutting direction, hold-down strategy and the sequence in which parts are machined all influence the quality of the finished components.

    CNC production is therefore not simply a matter of sending a drawing to a machine; the manufacturing logic has to be considered throughout the file preparation process.

    Nested CNC toolpaths arranged efficiently across plywood for scenic component production

    Nesting, toolpaths and tolerances are resolved before material reaches the CNC bed.

    CNC Routing For Complex Scenic Construction

    CNC routing is one of the most useful digital manufacturing processes within scenic carpentry.

    Sheet materials can be cut into structural ribs, wall profiles, templates, decorative panels, flooring components, signage elements and intricate joinery with consistent results. For scenic structures that rely on layered construction or complex profiles, routing allows shapes to be reproduced accurately without requiring every component to be manually marked and cut.

    Curved structures are a good example. A flowing scenic wall may require dozens of ribs, formers or profiles, each slightly different from the next. Producing those pieces manually would introduce considerable setting-out time and increase the possibility of cumulative dimensional errors.

    CNC-machined components allow the geometry to be controlled digitally before the structure reaches the assembly stage, giving scenic carpenters a much more reliable starting point for the build.

    Evolution Scenic CNC router cutting plywood components for a scenic wall assembly

    CNC routing produces accurate plywood parts for complex scenic structures and feature walls.

    Beyond Sheet Materials: Foam & Sculptural Production

    Digital manufacturing also extends into sculptural scenic work.

    CNC foam cutting, hot-wire cutting and more advanced machining processes can generate large three-dimensional forms that would otherwise require extensive manual carving. These processes are particularly useful for oversized props, architectural features, mould-making forms and complex decorative elements.

    The digitally produced shape may only be the beginning of the fabrication process; scenic artists can then carve, texture, hard-coat, paint and finish the surface to achieve the required appearance.

    Image description

    Accuracy & Repeatability

    One of CNC production’s greatest advantages is repeatability. Producing one component accurately is useful, but producing fifty components that match one another closely can transform the efficiency of a scenic build.

    Repeated display units, decorative details, structural ribs, plinth components or branded elements can be manufactured from the same controlled digital information rather than being individually set out by hand.

    Accuracy also improves the way separate workshop disciplines interact. Correctly machined joints help timber assemblies fit together more predictably.

    Locating holes can control alignment between components. Templates can position metal brackets consistently, while accurately produced formers can guide cladding and finishing work. The objective is not to chase unrealistic machining tolerances for their own sake, but to use appropriate precision to make the wider fabrication process more controlled.

    Identical CNC-machined scenic components stacked ready for repeatable workshop assembly

    Repeatability keeps matching components consistent across one-off builds and large production runs.

    Scaling Scenic Manufacturing

    These advantages become increasingly important as projects increase in size. A scenic installation containing hundreds of individual components can quickly become difficult to manage if every piece depends on manual measurement. Digital manufacturing allows components to be organised, labelled and reproduced systematically.

    Part identification can be incorporated into production files, allowing workshop teams to understand where individual pieces belong during dry fitting and final assembly.

    Scalability also matters when a scenic environment needs to be reproduced across multiple locations. Retail installations, pop-ups and branded environments often require similar structures to be manufactured more than once, sometimes with minor adaptations for different sites.

    Once the manufacturing information has been properly developed, CNC-ready components can be reproduced or adjusted without rebuilding the fabrication process from the beginning. The digital production file effectively becomes part of the project’s manufacturing knowledge.

    Evolution Scenic labelled CNC components organised for a large-scale scenic fabrication build

    Digital production helps large scenic projects remain organised as component quantities increase.

    Heritage-Inspired Fabrication

    CNC production is particularly useful for cultural and heritage-inspired work where repeated geometric details can become extremely complex. Decorative screens, layered patterns, relief panels and architectural motifs may involve hundreds of carefully controlled curves or intersections. Digital drawing allows these elements to be developed accurately, while CNC machining makes it practical to reproduce the geometry at scenic scale.

    The machine itself does not create authenticity, however. Heritage-inspired scenic fabrication still requires careful interpretation of proportion, material, depth and finish. A precisely cut pattern can feel completely wrong if its scale or surface treatment has been poorly considered.

    The value of CNC lies in giving the fabrication team control over the geometry, leaving experienced craftspeople and scenic artists to determine how that geometry should ultimately look and feel.

    CNC-carved heritage-inspired pattern within a decorative scenic panel for cultural fabrication

    CNC machining can reproduce intricate heritage geometry while retaining controlled scale and proportion.

    Digital Production Meets Traditional Workshop Skills

    CNC production does not replace scenic carpentry, metal fabrication or skilled workshop labour. A router cannot decide whether a timber edge requires reinforcement, whether an assembly can realistically be lifted into position or whether a connection will remain accessible during installation. Those decisions still depend on experienced fabricators understanding how the components will behave once they leave the machine bed.

    In practice, digital manufacturing works best when it supports traditional workshop disciplines. CNC-cut parts may be assembled by carpenters, reinforced by fabricated steelwork, clad with sheet materials and passed to scenic artists for finishing.

    The machine can also manufacture jigs, setting-out templates and drilling guides that make manual processes more consistent. This relationship between digital accuracy and practical fabrication judgement is where much of CNC’s real value sits.

    Evolution Scenic carpenters assembling CNC-machined components into a practical scenic structure

    Machine accuracy becomes useful only when experienced fabricators turn components into buildable scenery.

    Installation Efficiencies Start In The Workshop

    Accurate components can also reduce installation time. Scenic structures are frequently assembled under tight site programmes, with limited opportunities for significant adjustment once materials arrive. Components that have been dry-fitted and manufactured within a controlled digital workflow are more likely to align correctly when reassembled.

    Predetermined fixing points, repeatable interfaces and accurate panel dimensions can remove a considerable amount of measuring and modification from the site team.

    The same approach supports transportation and modular construction. Large structures can be divided digitally into sections that suit vehicle capacities, access routes and installation sequencing.

    Modules can be numbered before leaving the workshop and their connection points coordinated during manufacture.

    CNC accuracy therefore contributes not only to the appearance of a finished scenic structure, but also to how efficiently it can be packed, transported and reconstructed.

    Pre-machined scenic panels aligning accurately during efficient on-site installation

    Accurate machining reduces adjustment on site and helps installation teams assemble structures efficiently.

    Precision Is Only Useful When It Builds Well

    The most successful use of CNC in scenic fabrication is not about replacing traditional manufacturing with machines.

    It is about using digital production where it genuinely improves the build. CNC routing, foam cutting and other manufacturing processes allow complex information to move efficiently from technical design into the workshop, improving repeatability, scalability and control.

    But scenic projects still depend on skilled people making practical decisions. Materials move, tolerances accumulate and installation conditions rarely behave exactly as they do inside a CAD model. By combining CNC precision with experienced carpentry, metal fabrication, scenic finishing, logistics and installation knowledge, fabrication teams can produce complex environments that are both digitally accurate and genuinely buildable

    Finished scenic structure combining CNC precision with traditional hand fabrication and finishing

    The strongest results combine digital manufacturing accuracy with experienced scenic fabrication judgement.

  • Why Large Logos Are Harder To Build Than They Look

    Image description

    Why Large Logos Are Harder To Build Than They Look

    Few scenic elements appear simpler than a giant logo.

    A company name positioned outside a venue, oversized letters within an activation or a large branded feature placed at the centre of an event environment can often look straightforward in concept visuals. The form is familiar, the graphics are recognisable and the finished object may appear to consist of little more than enlarged lettering.

    The reality is usually very different.

    As logos increase in size, structural challenges increase rapidly. Weight, stability, transportation and installation requirements all become more significant. Details that are almost irrelevant at tabletop scale can become critical when a letter is several metres high, exposed to the weather or positioned where members of the public can approach it.

    A one-metre-high logo may require little more than a simple support system. A five-metre-high logo operating outdoors may require engineering calculations, concealed steelwork, ballast systems and specialist lifting or installation methods.

    The most successful large-scale logos are therefore not simply enlarged graphics. They are temporary structures that must be designed, fabricated, transported and installed as complete engineered objects.

    Size Changes Everything

    Scaling up a logo is rarely as straightforward as multiplying every dimension.

    As a structure becomes taller and wider, its surface area increases, its centre of gravity changes and the forces acting upon it become more significant. A letter that is stable at one metre high may behave entirely differently at four or five metres.

    Even relatively simple typefaces can create awkward structural conditions. Narrow uprights, projecting serifs, curved letterforms and large unsupported areas may all require reinforcement. Letters such as “T”, “F” or “L” can introduce pronounced overhangs, while rounded forms may need carefully designed internal framing to maintain their shape.

    The depth of each letter must also be considered. A deeper construction can increase rigidity and provide space for internal steelwork, but it may also add weight, increase transport volume and alter the appearance of the logo.

    For scenic fabricators, the task is to preserve the intended proportions while creating something that can withstand real-world handling and use.

    Freestanding Letters Need More Than a Flat Base

    Freestanding letters are particularly deceptive.

    A row of oversized letters may appear to sit neatly on the ground, but the visible base is only one part of the support system. The structure must resist overturning, sliding, twisting and movement caused by handling or accidental contact.

    Where possible, adjacent letters may be connected through a concealed base frame. This allows loads to be distributed across the full installation rather than relying on each letter independently. Individual letters may also contain internal steel frames, weighted base sections or hidden fixing points.

    The design of these systems depends heavily on the setting. A logo installed on a level exhibition floor has very different requirements from one positioned on grass, gravel, paving or a temporary event deck.

    Freestanding elements used in public environments must also be considered from every accessible side. Visitors may lean against them, touch them or use them as photo opportunities. Although this interaction may not appear in the original render, it influences the build methodology.

    Sharp corners, exposed fixings and unstable projections must be avoided. The structure should feel solid without revealing the engineering that makes it secure.

    Outdoor Logos and Wind Loading

    Outdoor logos introduce another level of complexity because they behave like sails.

    Large, flat letter faces can catch substantial wind, particularly when installed in exposed locations. Even an open wordmark can present a considerable combined surface area. The taller the logo, the greater the leverage created by forces acting towards its upper edge.

    Wind loading influences almost every aspect of the design, including the internal frame, base dimensions, connection details and ballast requirements. The surrounding environment also matters. A logo positioned between buildings may experience different wind behaviour from one installed in an open festival field or on an elevated terrace.

    Fabrication teams must understand where the structure will be installed, how long it will remain in place and what level of exposure it may encounter. Local conditions, seasonal weather and the presence of nearby temporary structures can all affect the design approach.

    In some cases, the scenic finish can be applied over a lightweight skin supported by an engineered steel skeleton. In others, the letterforms may be divided into sections or designed with openings that reduce wind resistance while preserving the visual character of the branding.

    The objective is not to overbuild the structure unnecessarily. It is to create an appropriate, proportionate solution based on its location and intended use.

    Hidden Steel Reinforcement

    Steel reinforcement is often essential for large-scale branded installations, but it should rarely dominate the finished appearance.

    Internal steelwork can provide rigidity, connect individual components and transfer loads into a base or ballast system. It may be fabricated as a series of welded frames, removable brackets or modular sections that bolt together on site.

    The relationship between the steel frame and the scenic outer surface requires careful coordination. The frame must support the letter without distorting its shape or creating visible fixing points. It also needs to allow enough access for assembly, inspection and future dismantling.

    Where logos incorporate illuminated faces, graphics or specialist finishes, additional allowances may be required for cabling, ventilation, access panels and replaceable components.

    Evolution Scenic approaches these installations as combined engineering and fabrication projects. Scenic carpentry, metal fabrication, CNC machining, graphics and finishing all need to work from the same coordinated design. A change to the internal frame can affect the outer skin, while a change to the finish may alter the available fixing methods.

    This is why large logos benefit from being developed as complete systems rather than as separate decorative letters.

    Material Selection Is a Balancing Exercise

    The objective is rarely to make a logo as strong or as heavy as possible.

    Instead, scenic fabrication teams aim to achieve the correct balance between weight, strength, transportation efficiency and visual appearance.

    Timber, plywood, aluminium, steel, composite sheets, foams and specialist plastics may all be used within the same installation. CNC machining can create precise letter profiles, while lightweight skins can be fixed over internal frameworks to produce substantial forms without excessive mass.

    Material choice also depends on the finish. A perfectly smooth painted surface may require a different substrate from a textured scenic finish or applied vinyl graphic. External installations may need moisture-resistant materials, sealed edges and coatings capable of tolerating short-term exposure to changing weather.

    Durability must be considered across the entire project lifecycle. The logo must survive fabrication, finishing, loading, transportation, installation, use and dismantling. Damage frequently occurs not while the structure is standing, but while it is being moved through loading bays, lifted from vehicles or assembled under time pressure.

    A good material specification accounts for all of these stages.

    Transport Shapes the Design

    One of the most important questions in large-logo fabrication is not how big the finished structure will be, but how small it needs to become for transport.

    A logo may need to pass through workshop doors, fit within a specific vehicle, travel in standard freight cases or move through restricted venue access routes. Weight limits, loading equipment and local handling resources also affect the design.

    Large letters are therefore often fabricated in sections. The joints must be strong, repeatable and visually discreet. Alignment pins, bolted plates, internal sleeves and concealed connection brackets can allow components to be assembled accurately on site.

    The order of assembly is equally important. Fixings must remain accessible, and each section must be manageable using the lifting equipment available. There is little value in designing a lightweight structure if one awkward component still requires an impractical handling method.

    Protective packaging is another part of the fabrication strategy. Curved faces, projecting details and high-gloss finishes are vulnerable during transport. Purpose-made stillages, padded cases and shaped supports may be required to prevent movement and surface damage.

    Transport planning is therefore not a separate logistics exercise. It is part of the design process from the beginning.

    Installation Methods Must Suit The Site

    Installation conditions can vary significantly between festivals, product launches, corporate events and public activations.

    A logo may be installed using manual handling, pallet trucks, telehandlers, mobile cranes or specialist lifting frames. The method depends on the size of the components, the site conditions and the available installation window.

    Ground conditions are particularly important outdoors. Soft ground, slopes and uneven surfaces can affect both the structure and the equipment used to position it. Adjustable feet, spreader plates or temporary foundations may be needed to create a stable installation.

    Indoor venues present different constraints. Access doors, ceiling heights, floor loading limits and restricted rigging points may dictate how the logo is divided and assembled. In busy exhibition halls or event spaces, installation may also need to take place alongside multiple other contractors.

    Clear labelling, accurate setting-out information and well-tested connection details help make the process predictable. Wherever practical, assemblies should be trial-fitted in the workshop before they reach site. This allows the fabrication team to identify alignment issues, confirm the build sequence and verify that every component is present.

    The Engineering Should Disappear

    Large logos often need to withstand conditions that were never visible in the original render. Wind loading, uneven ground, public interaction and transportation stresses all influence their performance.

    None of these considerations should distract from the finished branding.

    The joints should remain discreet. The bases should feel intentional. Reinforcement should be concealed, and the structure should retain the clean lines, proportions and finish shown in the creative concept.

    Achieving that simplicity requires collaboration between designers, scenic carpenters, metal fabricators, CNC operators, scenic painters, graphics teams, engineers and site installers.

    The most successful logo installations are often the ones where visitors never notice the calculations, internal frameworks or carefully planned connection details.

    They simply see the branding.

  • How We Built A 12-Metre Scenic Sculpture

    Image description

    How We Built A 12-Metre Scenic Sculpture

    Large-scale scenic sculptures often appear effortless once installed. Visitors see a completed structure integrated into its environment, rarely considering the engineering, fabrication and logistical planning required to make that outcome possible.

    At 12 metres high, a scenic sculpture is no longer simply an enlarged decorative object. It becomes a temporary engineered structure that must perform safely throughout fabrication, transportation, lifting, assembly and operation.

    The challenges begin long before manufacturing starts. As a structure increases in scale, its weight, centre of gravity, wind exposure and transportation requirements become increasingly influential. Decisions that appear minor during concept development can have significant consequences once production begins.

    The success of a sculpture at this scale therefore depends on treating engineering, scenic fabrication and logistics as parts of one coordinated process.

    Understanding the Challenges of Scale

    Increasing the size of a sculpture changes more than its dimensions.

    A narrow feature that appears stable within a digital model may become a substantial unsupported projection when built at full size. A curved surface that seems relatively simple may require several structural members, machined components and joining points to retain its form.

    Large surface areas can also introduce wind-loading considerations, particularly when the sculpture is installed outdoors. Weight must be controlled without compromising stability, while the base structure must safely transfer loads into the supporting platform, foundation or temporary installation system.

    Workshop limitations must also be considered. A 12-metre sculpture will rarely fit beneath a standard workshop roof as one complete assembly. Even when sufficient height is available, manufacturing the structure vertically may not be the safest or most efficient approach.

    The sculpture must therefore be designed around the realities of production. It may need to be fabricated horizontally, divided into sections or temporarily assembled in smaller groups before being transported to site.

    These decisions affect every later stage of the project.

    Developing the Sculpture Digitally

    The process usually begins with a three-dimensional model representing the intended external form.

    This model provides a starting point, but it is not necessarily ready for manufacture. Technical designers must translate the visual concept into production information that can be understood by engineers, metal fabricators, scenic carpenters, CNC operators, sculptors and installation teams.

    The digital model is reviewed to identify structural zones, connection points and potential fabrication sections. Large curves and irregular surfaces may be divided into manageable components that can be manufactured using CNC machining, foam carving, timber construction or formed sheet materials.

    The model must also account for the thickness of coatings, cladding and scenic finishes. Even small material allowances can affect how separate sections align when assembled.

    Digital coordination allows potential conflicts to be identified before materials reach the workshop. It also helps the team assess the overall weight, module dimensions and likely centre of gravity of each component.

    For a structure of this scale, the digital model is not simply a visual reference. It becomes an important part of the fabrication and installation methodology.

    Image description

    Structural Engineering and Technical Reviews

    Behind the finished scenic surface sits an internal structure designed to carry loads and maintain the sculpture’s geometry.

    Structural steel is often used for the primary framework because it provides predictable strength, reliable mechanical connections and suitable lifting points. Aluminium, timber and plywood may also be incorporated where lower weight or more complex shaping is required.

    The engineering solution must respond to the form rather than working against it. Structural members need to fit within the available internal space without distorting the external silhouette or becoming visible through the finished surface.

    Technical and structural reviews consider factors such as:

    • The overall height and weight of the sculpture
    • The stability of the completed structure
    • Wind and environmental loading
    • The strength of connections between modules
    • Lifting and handling forces
    • Temporary stability during installation
    • Base plates, anchoring systems and ballast
    • Public proximity and accidental impact

    The sculpture may be stable when fully assembled but vulnerable while individual modules are being lifted or connected. Temporary bracing and installation sequencing must therefore form part of the engineering strategy.

    Lifting points are also designed into the structure rather than added as an afterthought. Their position must allow each module to remain controlled and balanced during movement.

    These details are rarely visible after installation, but they are essential to delivering the sculpture safely.

    Designing a Modular Construction Strategy

    A 12-metre scenic sculpture can rarely be transported as a complete object.

    Road restrictions, vehicle dimensions, workshop access and site conditions usually make modular construction necessary. The sculpture is divided into sections that can be manufactured, handled and transported independently before being assembled at its final location.

    Determining where to divide the structure requires careful judgement.

    Modules must be small enough to fit within transport and lifting limitations, but excessive segmentation creates more joints, additional fabrication work and longer installation times.

    Connection points should remain structurally reliable while being accessible to the installation team. Wherever possible, joints are located along natural changes in geometry, recessed areas or surface transitions where they can be concealed more effectively.

    The modular approach also influences the internal frame. Steel members may terminate at bolted flange connections, while scenic surfaces may include removable sections that provide access to the structural fixings.

    Projects such as the Nano Robot Structure demonstrate how complex public sculptures can be broken into coordinated fabrication modules. Structural frameworks, CNC-produced forms and detailed scenic surfaces can be manufactured separately before being brought together as one finished installation.

    The objective is to ensure that the completed sculpture reads as a continuous form, even though it has been designed around transportation and assembly requirements.

    Image description

    Selecting Materials for Strength and Weight

    Material selection becomes increasingly important as scenic structures grow in size.

    A sculpture built entirely from heavy materials may create unnecessary demands on transport vehicles, cranes, foundations and installation crews. A structure built entirely from lightweight materials may lack the strength needed to withstand lifting, environmental exposure or public interaction.

    The most effective solution is usually a hybrid construction system.

    Steel may provide the primary support structure, while timber or plywood creates secondary framing and localised fixing zones. CNC-carved foam can produce complex volumes and curved surfaces without introducing excessive weight. Other areas may use fibreglass, formed plastics, printed elements or lightweight composite panels.

    Each material is selected for a specific purpose.

    Foam, for example, is particularly valuable when creating large sculptural volumes, but it requires suitable reinforcement and protective coatings. Exposed corners, projecting details and areas close to the public may need harder surface systems or locally strengthened construction.

    Similarly, scenic coatings must be chosen according to the operating environment. An indoor installation may require a different finish from a public sculpture exposed to heat, moisture, dust and ultraviolet light.

    Material decisions must balance appearance, durability, weight, manufacturing time and cost. The least expensive material in isolation is not always the most efficient choice once transport, installation and maintenance are considered.

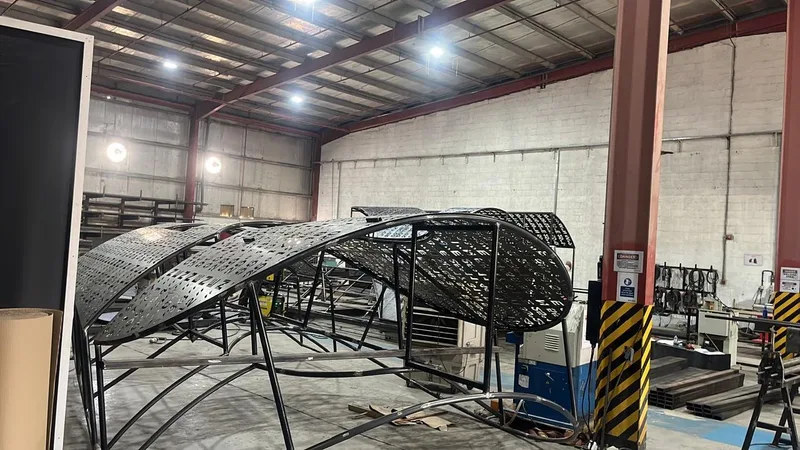

    Image description

    Fabricating and Testing the Modules

    Once the technical design and engineering strategy are approved, manufacturing can begin.

    The internal framework is typically fabricated first, providing a controlled structure around which the sculptural form can be developed. Steel components are cut, welded and checked against technical drawings before secondary framing and scenic materials are added.

    CNC machining allows complex components to be produced directly from digital information. Large foam sections, profiles and surface forms can be cut accurately before being refined by scenic sculptors.

    The modules are then coated, prepared and painted using finishes appropriate to the final design and operating conditions.

    Where workshop space allows, key sections are test-fitted before dispatch. This stage confirms that structural connections align, scenic surfaces meet correctly and installation access remains available.

    Test assembly is particularly important for irregular sculptures. Small tolerance differences can accumulate across multiple modules, creating significant alignment problems at full height.

    Resolving these issues in the workshop is considerably more efficient than attempting to correct them during a time-sensitive site installation.

    Planning Transportation

    Transportation planning begins during technical design, not when fabrication is complete.

    Every module must fit within vehicle dimensions and road transport restrictions. Fabricators must also consider how components will move through workshop doors, loading bays, venue entrances and the final installation area.

    Large scenic components may be lightweight relative to their size but still difficult to handle. Their irregular forms can create vulnerable projections and inefficient loading volumes.

    Custom transport stillages are often manufactured to support the modules securely. These frames prevent movement during transit and protect finished surfaces from impact, vibration and pressure.

    The loading sequence is coordinated with the installation programme. Components required first on site should be positioned so they can be unloaded without moving or exposing later modules unnecessarily.

    Lifting points and handling instructions must remain accessible throughout the journey. Protective packaging should safeguard the scenic finish without preventing installation crews from identifying connection zones or module references.

    The transport strategy is therefore closely connected to the fabrication and assembly methodology.

    Installing the Sculpture on Site

    Site installation is where the engineering, manufacturing and logistical planning come together.

    The base structure is positioned first and checked against site coordinates, levels and fixing locations. Any discrepancy at this stage can affect the alignment of every module above it.

    The sculpture is then assembled according to a planned sequence. Lower structural sections are normally secured before upper modules are lifted into position.

    Each lift must account for the component’s weight, dimensions and centre of gravity. Spreader beams, lifting frames or multiple connection points may be required to prevent the module from rotating or deforming.

    Temporary supports can stabilise the sculpture while the remaining sections are installed. These are removed only after the primary connections have been completed and inspected.

    Once the structural assembly is finished, scenic teams close the visible joints between modules. Seams are filled, coatings are repaired and painted finishes are carefully matched so that the final sculpture appears continuous.

    Access becomes more difficult as the structure increases in height, so the sequence of final finishing must also be planned. Certain joints may need to be completed from elevated work platforms before access is restricted by additional modules.

    Site installation is rarely a simple matter of connecting prefabricated sections. It requires experienced teams capable of responding to changing conditions while protecting the engineering and visual integrity of the sculpture.

    Image description

    Maintaining the Original Design Intent

    One of the greatest challenges throughout the project is maintaining consistency between the original concept and the completed installation.

    Engineering requirements may require adjustments to proportions, support locations or material thicknesses. Transportation restrictions may influence where modules are divided. Site conditions may affect the base design or lifting methodology.

    The objective is not to prevent technical changes. It is to integrate them without weakening the sculpture’s intended form.

    Close coordination between designers, engineers and fabricators allows structural requirements to be absorbed into the sculpture rather than applied visibly afterwards.

    This is where practical scenic experience becomes especially valuable. Understanding how materials behave at scale makes it possible to preserve important curves, profiles and surface transitions while introducing the reinforcement needed for safe delivery.

    Image description

    One Connected Fabrication Process

    Large sculptures succeed when engineering, fabrication, transportation and installation are considered as a single delivery strategy rather than separate activities.

    The size of each module affects the transport plan. The transport plan affects the location of structural joints. The structural joints influence the scenic surface, and the surface design determines how successfully those joints can be concealed.

    Every decision is connected.

    For Evolution Scenic, building a 12-metre sculpture is not simply an exercise in making something visually impressive. It is a process of solving structural, manufacturing and logistical challenges while retaining the clarity of the original design.

    The completed sculpture may appear effortless once installed, but that outcome is achieved through detailed technical design, coordinated fabrication and a carefully controlled site methodology.

  • Choosing Materials For Scenic Fabrication

    Scenic team gathered around a table reviewing plans and material samples in an office.

    Choosing Materials For Scenic Fabrication

    Material selection is one of the most important decisions made during any scenic fabrication project. The materials chosen during technical development influence far more than the finished appearance. They affect structural engineering, fabrication methodology, transportation, installation sequencing, maintenance and the overall lifespan of the environment.

    There is rarely a single correct material for a scenic structure. Two materials may produce an almost identical visual result while behaving very differently during manufacturing and operation. The strongest solution is therefore not necessarily the heaviest, most permanent or most familiar material. It is the material, or combination of materials, that responds most effectively to the project’s structural, environmental and operational requirements.

    This is why scenic fabrication rarely begins with a material in isolation. It begins with questions.

    How long must the installation remain in operation? Will it be installed indoors or outdoors? Does it need to be transported, stored or reused? Will people touch or interact with it? Are integrated lighting, graphics or technology involved? How will maintenance teams reach concealed components?

    Timber: Flexible, Familiar and Highly Adaptable

    Timber remains one of the most versatile material groups used in scenic fabrication. Softwood framing, plywood, birch ply, MDF and specialist boards can all perform different roles within the same environment.

    Timber structures can be manufactured efficiently, modified during production and adapted on site when necessary. Curved walls, scenic flats, display units, plinths, portals and temporary partitions can often be produced using CNC-cut plywood ribs combined with timber grounds and sheet cladding.

    However, timber is not one universal product. MDF provides a smooth surface for painted finishes and CNC-machined details, but standard grades are vulnerable to moisture. Plywood generally offers better structural performance, although its strength depends on its grade, thickness, veneer quality and the direction of the grain. Birch ply is frequently selected where exposed edges, accurate machining or a premium natural finish are required.

    Moisture content, fire performance, edge sealing and fixing methods must all be considered. A timber wall designed for a short indoor exhibition will require a very different specification from timber joinery intended to operate for several years inside a visitor centre.

    Crew members work on the exposed metal frame of a wheeled scenic platform beside a partially fitted timber deck.

    Steel: Strength Where It Is Needed

    Steel is often introduced when scenic structures require greater spans, concentrated load capacity, cantilevered elements or reliable connection points.

    Welded steel frames can create stable foundations beneath large scenic forms without making the supporting structure visually dominant. Rectangular and square hollow sections are commonly used for base frames, portals, platforms and internal skeletons. Plates, brackets and gussets allow loads to be transferred through controlled structural connections.

    Steel is particularly valuable where structures must support integrated equipment, suspended elements, movement or repeated installation cycles. It can also provide the ballast and low-level weight needed to improve stability beneath tall scenic features.

    The design must still account for fabrication tolerances, lifting, access and transportation. A single welded frame may be structurally effective but impossible to move through a venue door. Larger systems are therefore frequently divided into transportable modules connected through bolted plates, sleeves or engineered joints.

    Corrosion protection is also important. Painted steel may be suitable indoors, while galvanising, specialist primers or more durable coating systems may be required for external use. The finish must be specified as part of the complete system rather than treated as a final cosmetic layer.

    Image description

    Aluminium: Reducing Weight Without Losing Precision

    Aluminium is widely used when weight, handling and repeat assembly are important. It is significantly lighter than steel and offers good corrosion resistance, making it useful for modular scenic frames, overhead elements, lightweight structures and systems that travel regularly.

    Reducing weight can simplify installation, decrease lifting requirements and improve transport efficiency. It can also allow larger scenic components to be handled safely by smaller teams where the installation methodology permits.

    Aluminium does, however, behave differently from steel. Connections, section sizes and welding methods must be developed specifically for the material. Thermal expansion can become relevant in exposed outdoor environments, and contact between aluminium and dissimilar metals may require isolation to reduce galvanic corrosion.

    For reusable environments, accurately manufactured aluminium frames can provide a durable internal structure beneath replaceable scenic skins. The structural chassis remains in service while graphics, finishes and branded surfaces change from one installation to another.

    Composites: Complex Forms and Controlled Surfaces

    Composite materials are valuable when scenic geometry becomes difficult to achieve through conventional sheet construction. Glass-reinforced plastic, fibre-reinforced panels, laminates and sandwich panels can create curved, lightweight or highly detailed components.

    Moulded GRP is especially effective where the same form must be repeated. Once the mould has been developed, multiple components can be produced with consistent geometry and surface quality. This can be useful for themed environments, museum installations, sculptural features and branded structures.

    Composite systems should still be assessed carefully. Laminate thickness, internal reinforcement, fixing inserts and edge conditions all influence performance. Fire and smoke requirements are particularly important for public interiors, and the performance of the completed system must be considered rather than relying on the description of an individual resin or facing material.

    The connection between the composite skin and its supporting frame is equally critical. A visually convincing shell can still fail operationally if access, movement, thermal expansion and fixing loads have not been properly resolved.

    A large timber scenic structure under construction inside a workshop.

    Foam: Shape Without Unnecessary Structural Weight

    Foam is one of the most useful sculpting materials within scenic fabrication. Expanded polystyrene, extruded polystyrene and polyurethane foams can be carved, hot-wire cut or CNC-machined into complex shapes that would be inefficient to construct from solid timber or metal.

    Foam is commonly used for oversized props, organic forms, rocks, relief panels, decorative profiles and lightweight scenic cladding. It is not normally expected to provide the primary structural frame. Instead, it creates the form while an internal timber, steel or aluminium system provides support.

    The coating system determines how the finished element behaves. Hard coatings, reinforced laminates, polyurea systems or specialist scenic coatings can improve impact resistance and create surfaces suitable for scenic painting.

    Solvent compatibility, heat exposure, fire performance and handling must be checked before production. Details such as vulnerable edges, fixing points and areas that may be touched by visitors often require reinforcement.

    An enclosed laser-cutting room inside a scenic fabrication workshop.

    CNC Materials and Digital Fabrication

    CNC machining has expanded the range of materials that can be used accurately within scenic construction. Plywood, MDF, PVC foamboard, acrylic, compact laminates, aluminium composite panels and certain solid-surface materials can all be cut or routed into repeatable components.

    The machine does not remove the need for material knowledge. Cutting speeds, tool selection, sheet holding, dust extraction and edge behaviour vary significantly between materials. A detail that machines cleanly in birch ply may chip in a laminate, melt in certain plastics or require specialist tooling in aluminium.

    Digital fabrication works particularly well when components must interlock, repeat or align with integrated technology. Numbered parts can be nested efficiently, produced in sequence and assembled into complex structures with controlled tolerances.

    The selected sheet material must still suit the final environment. CNC accuracy cannot compensate for moisture-sensitive boards used outdoors, unsuitable core materials or surfaces that cannot accept the required finish.

    Image description

    Comparing Common Scenic Materials

    Different scenic materials offer distinct advantages depending on the structural, visual and operational requirements of a project.

    Timber and plywood are adaptable, easy to modify and well suited to CNC production, making them useful for scenic walls, plinths, joinery, portals and temporary structures, although moisture, fire performance, grain direction and edge sealing must be carefully considered.

    MDF and other fibreboards provide smooth surfaces and allow accurate routed detailing, which makes them suitable for painted panels, decorative profiles and interior display units, but their weight, impact resistance and sensitivity to moisture can limit where they are used.

    Steel provides high strength, stable connections and reliable support for concentrated loads, making it appropriate for base frames, platforms, tall structures and internal structural skeletons, although its weight, corrosion protection and transportable module sizes must be planned from the beginning.

    Aluminium offers a lighter, reusable and corrosion-resistant alternative for modular frames, suspended features and touring systems, but connection design, thermal movement and galvanic isolation require specialist attention.

    GRP and other composites are particularly effective for producing complex forms, repeated components and controlled surface finishes, making them suitable for sculptural cladding and themed scenic features, while mould development, reinforcement, fixing methods and fire performance remain important considerations.

    Foam is lightweight and highly suitable for complex sculpting, including props, reliefs, organic forms and decorative cladding, but vulnerable edges, surface protection and fire performance must be addressed through the correct coating and reinforcement system.

    Specialist CNC sheet materials provide accuracy, repeatability and compatibility with digital fabrication workflows, making them valuable for layered graphics, interlocking structures and detailed panels, although tooling, core composition, edge finishing and environmental suitability must be matched carefully to the final application.

    Image description

    Environmental Conditions Change the Specification

    The visible material is only one part of the decision. Environmental conditions affect substrates, adhesives, coatings, fixings and connections.

    Outdoor scenic structures in the GCC may experience extreme surface temperatures, strong UV exposure, humidity, condensation, wind and airborne dust. Dark finishes can reach much higher temperatures than the surrounding air, creating thermal movement across panels and junctions. Adhesives may soften, plastics may distort and poorly sealed timber edges may absorb moisture.

    Wind loading can also influence the choice between solid and perforated surfaces. A large continuous wall may create significant structural loads, while a carefully engineered open or fabric-covered system can reduce wind pressure.

    UV-resistant coatings, sealed joints, corrosion-protected fixings and drainage details therefore form part of the material strategy. A durable outdoor system depends on how all its layers work together.

    Built-in timber shelving fills a colorful room with green-framed windows, painted wall graphics and orange ceiling slats.

    Designing for Durability and Maintenance

    Long-term scenic installations should be designed with maintenance in mind from the beginning.

    Materials within museums, visitor centres and experience environments may need to withstand repeated cleaning, visitor contact and continuous operation. Corners, plinth edges, doors and interactive areas normally receive more wear than elevated scenic surfaces.

    Replaceable finish panels can extend the useful life of the installation. Access hatches allow lighting drivers, screens, ventilation equipment and control systems to be serviced without damaging finished joinery. Standardised fixings make it easier to remove and reinstall components.

    The most durable material is not always the one that creates the best long-term environment. A heavy permanent skin may become a liability if it prevents access to technology behind it. A lighter replaceable panel may provide a more practical solution.

    Maintenance information should therefore be recorded as part of the handover process. Coating references, cleaning methods, spare materials and approved repair techniques help the operational team preserve the installation after fabrication is complete.

    Crew members assemble a wheeled scenic structure with tall arched walls and exposed metal framework inside a fabrication tent.

    Combining Materials Instead of Choosing One

    Many successful scenic environments use hybrid construction.

    A large feature wall may have a welded steel base, an aluminium secondary frame, CNC-cut plywood formers and composite cladding. A sculptural entrance portal may combine a structural metal skeleton with foam shaping, a reinforced hard coat and a specialist scenic paint finish.

    Each material performs the role it handles most effectively.

    This approach allows structural strength to be concentrated where loads occur, while lightweight materials create volume and form. Surfaces can be selected for finish quality, impact resistance or replaceability without requiring the entire structure to be manufactured from the same material.

    The success of a hybrid system depends on resolving the interfaces between materials. Differential movement, fixing access, coating compatibility and disassembly must all be considered during technical development.

    The Right Material for the Right Challenge

    Material selection is not an isolated purchasing decision. It is a technical process that connects the creative concept with engineering, manufacturing, installation and operation.

    Timber may provide the fastest route to an adaptable scenic structure. Steel may deliver the strength required beneath a large feature. Aluminium may make a touring system practical. Composites and foam may create geometry that conventional construction cannot achieve efficiently. CNC materials may introduce accuracy and repeatability across the entire build.

    The strongest scenic environments are rarely defined by one preferred material. They are defined by understanding how each material behaves and using it where it contributes most effectively to the complete fabrication system.
